AUGUST / 2020

BULDINGS WITHIN PLOTS

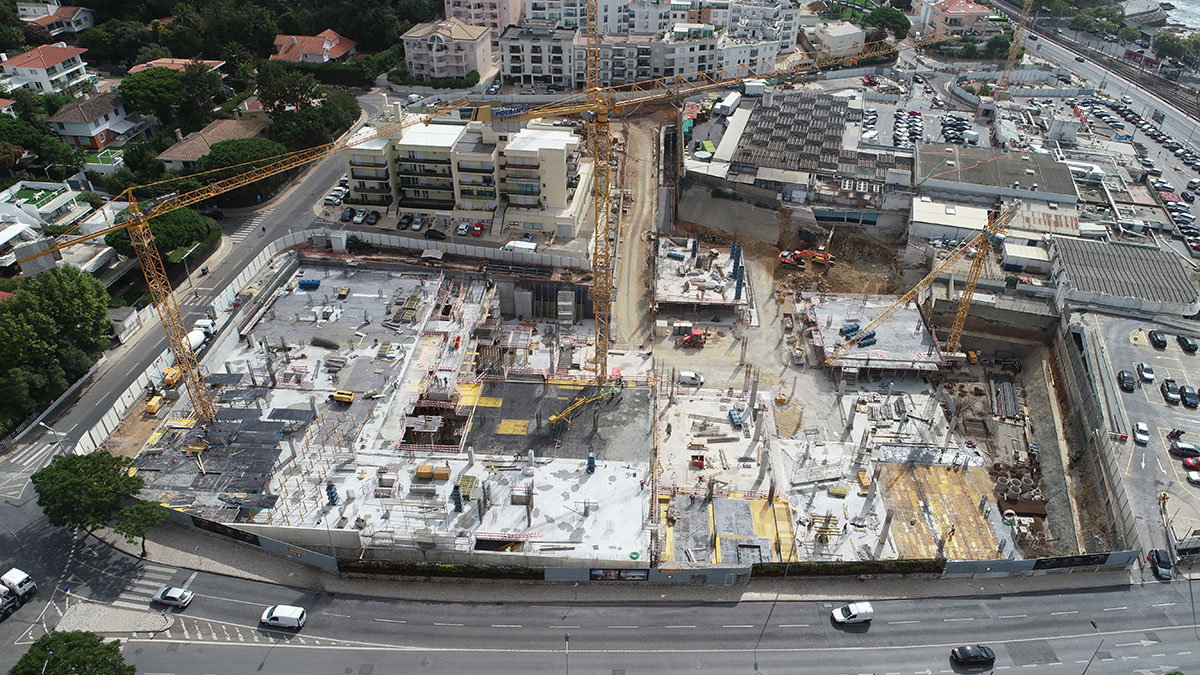

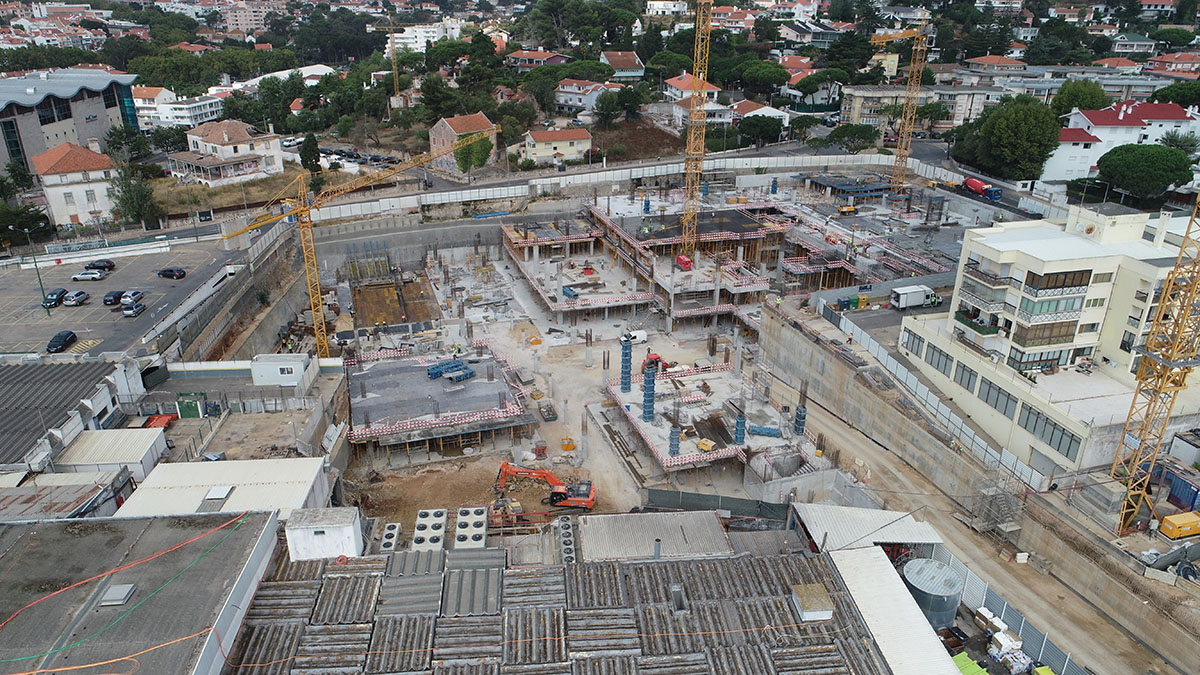

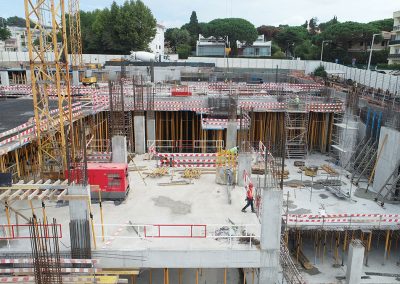

PLOT 2

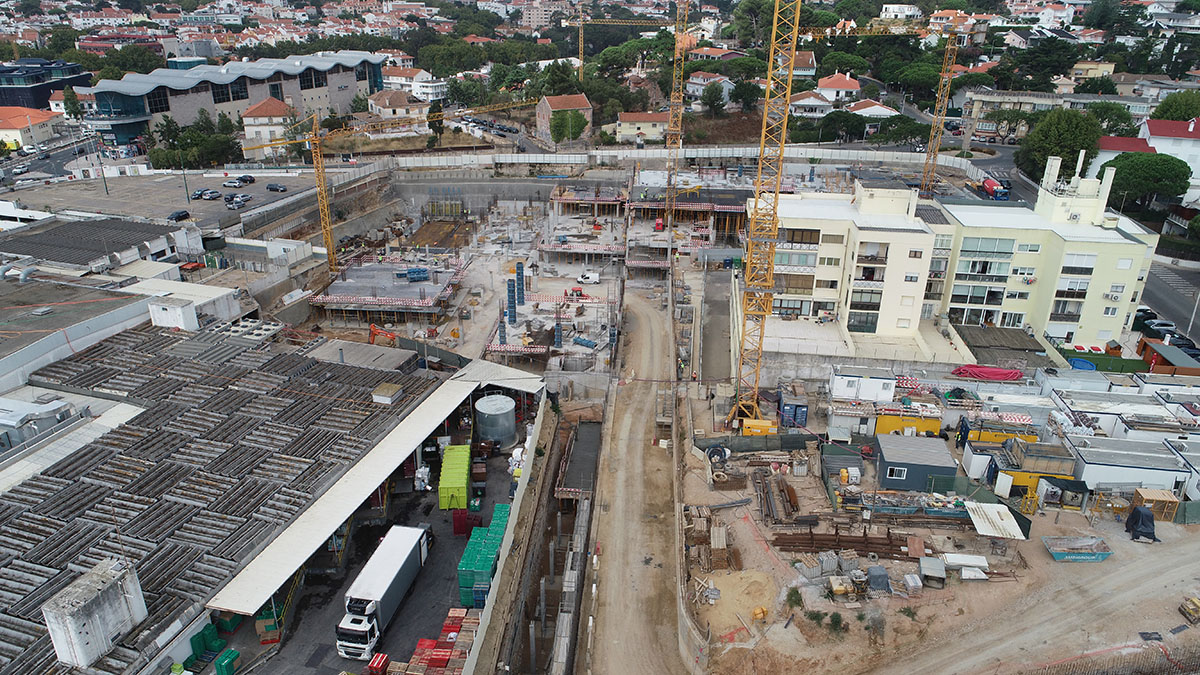

 Demolitions, Excavations, Containment and Foundations completed
 Drainage and Ground Slab concluded

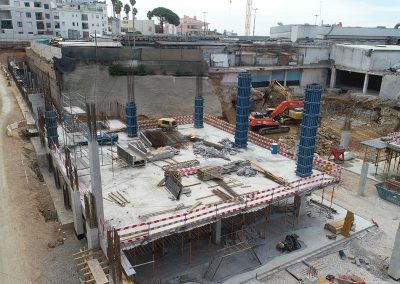

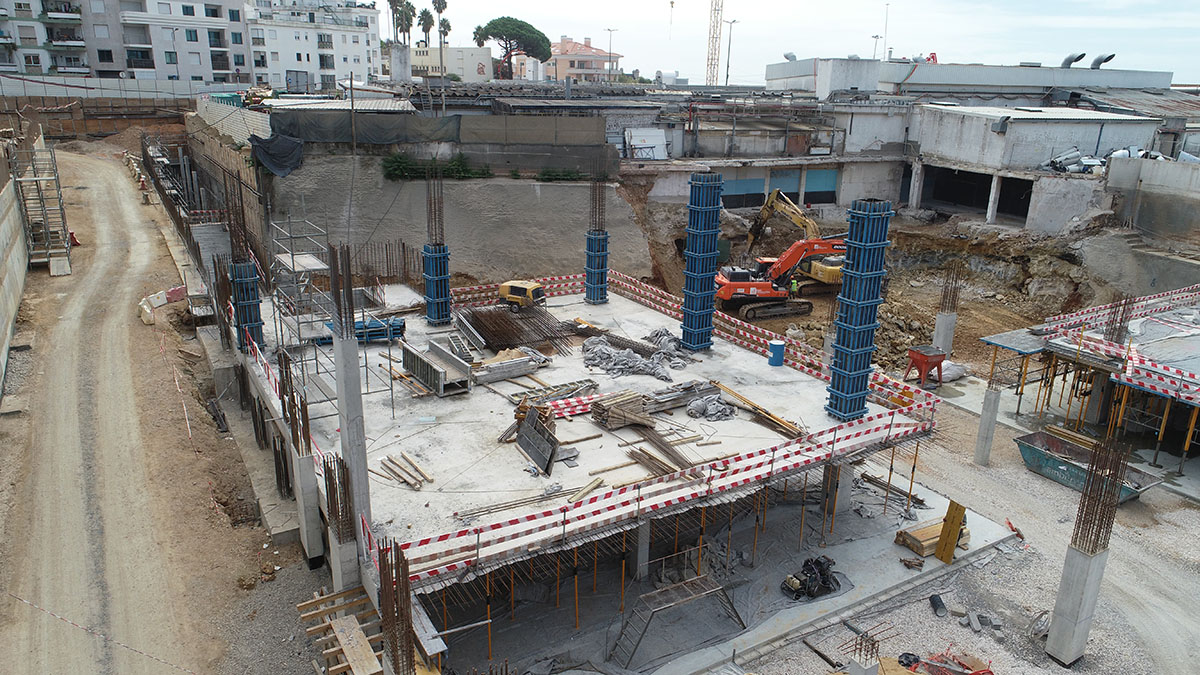

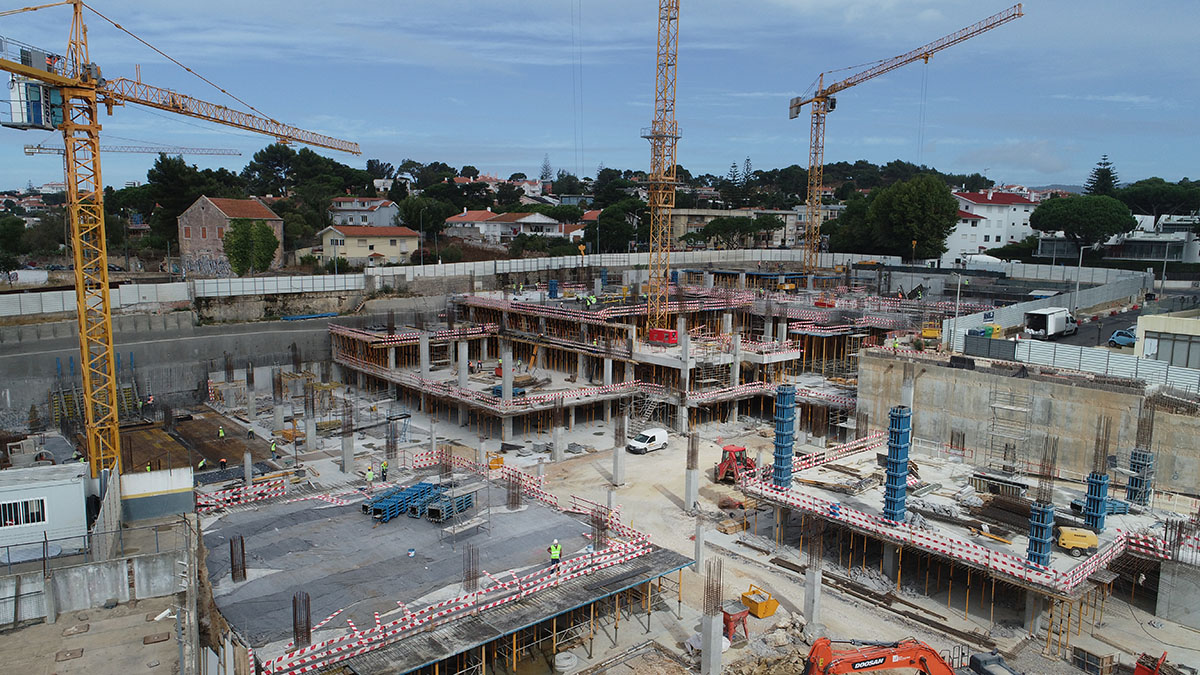

Vertical Elements and 1st Level Slab – Completed

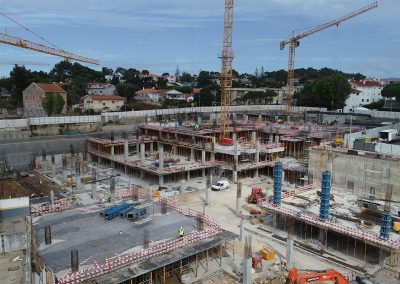

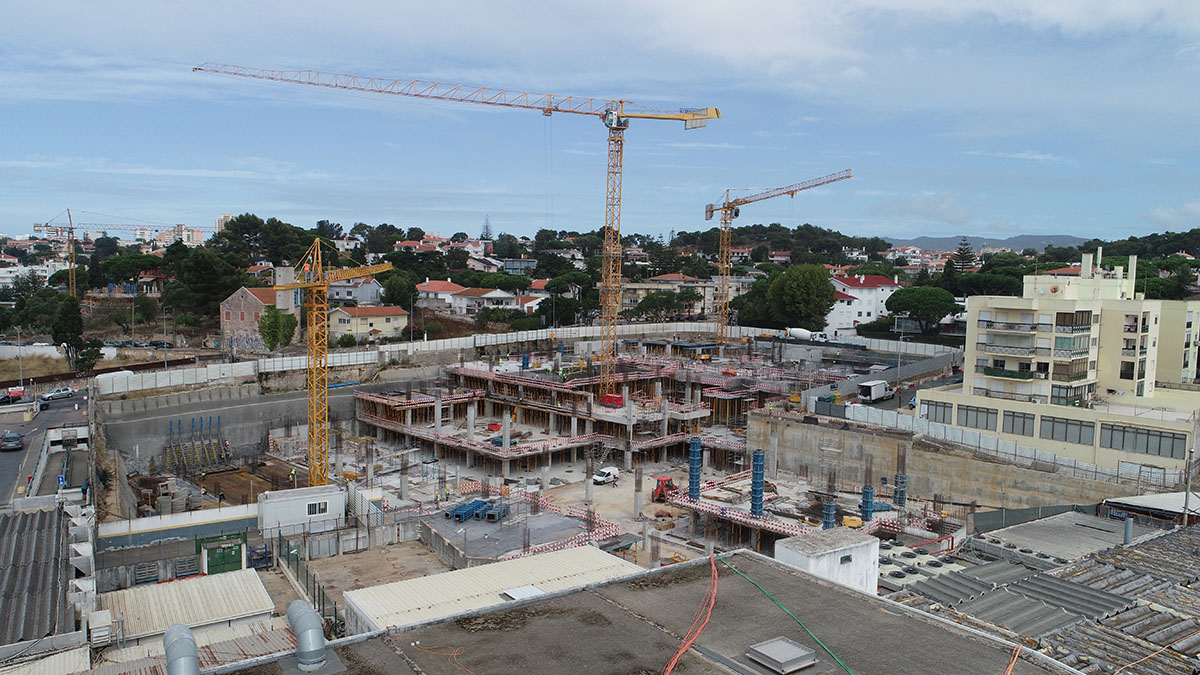

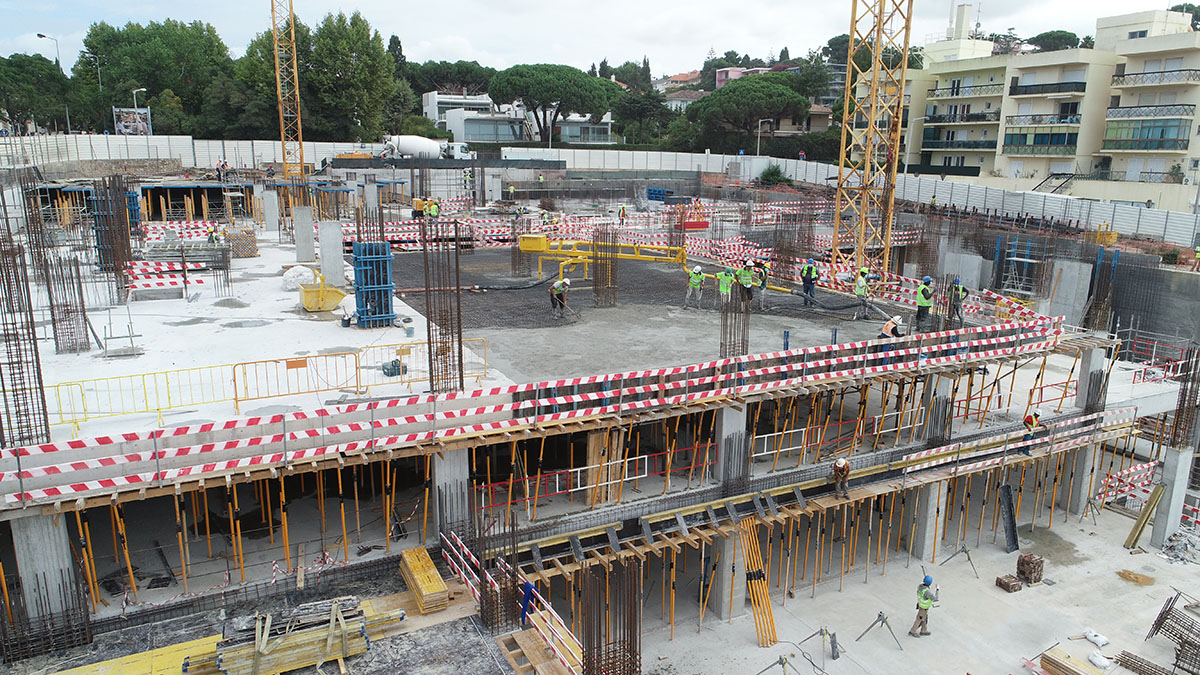

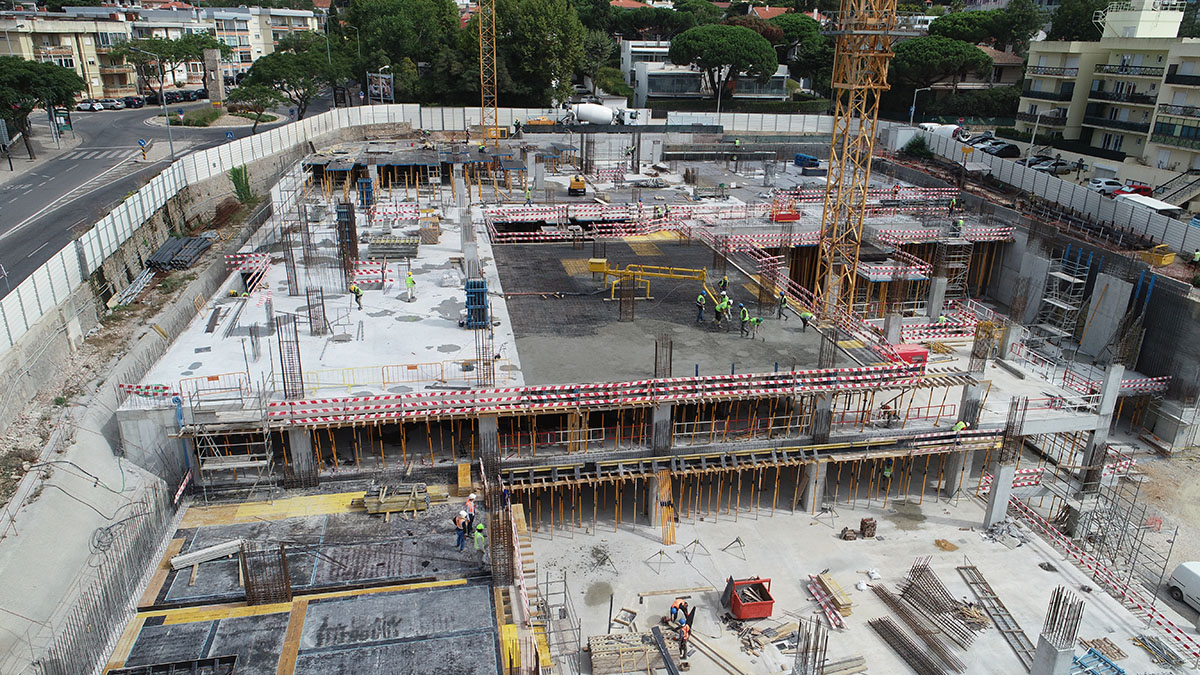

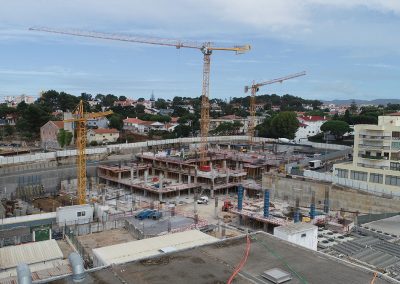

Vertical Elements and Intermediate and 2nd Level Slabs – In great progress

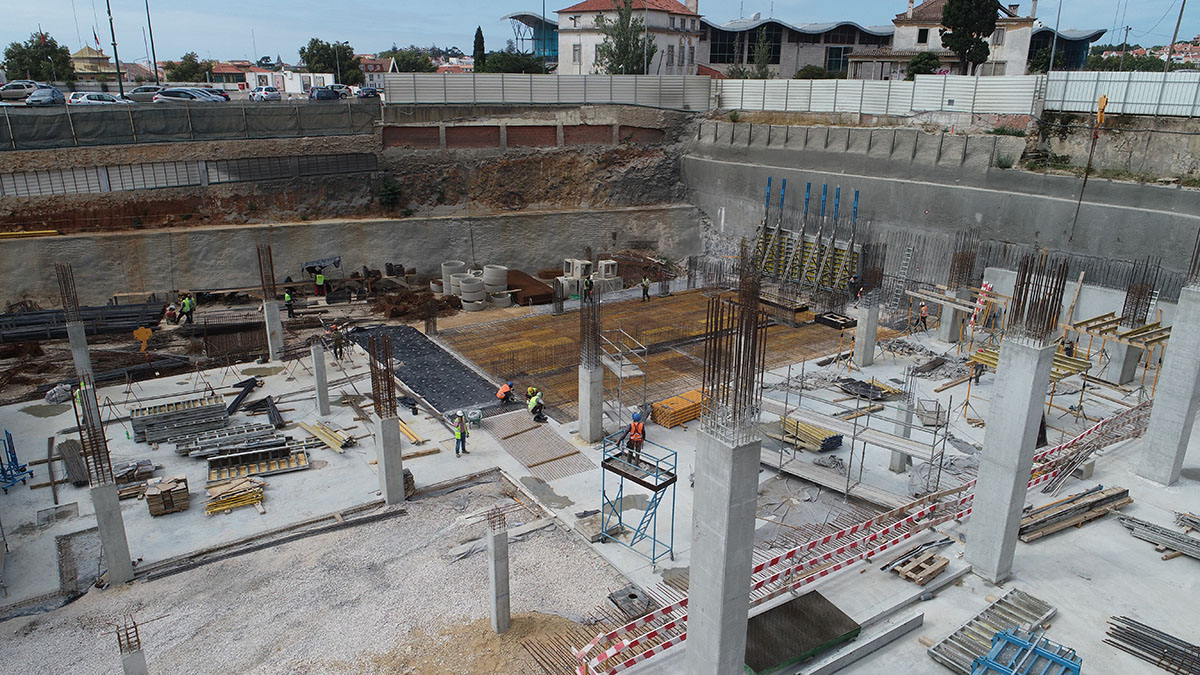

The Excavations and Containment of the 2 north ramps to Av. Marechal Carmona have been completed. Excavation and ramp 3 containment have begun.

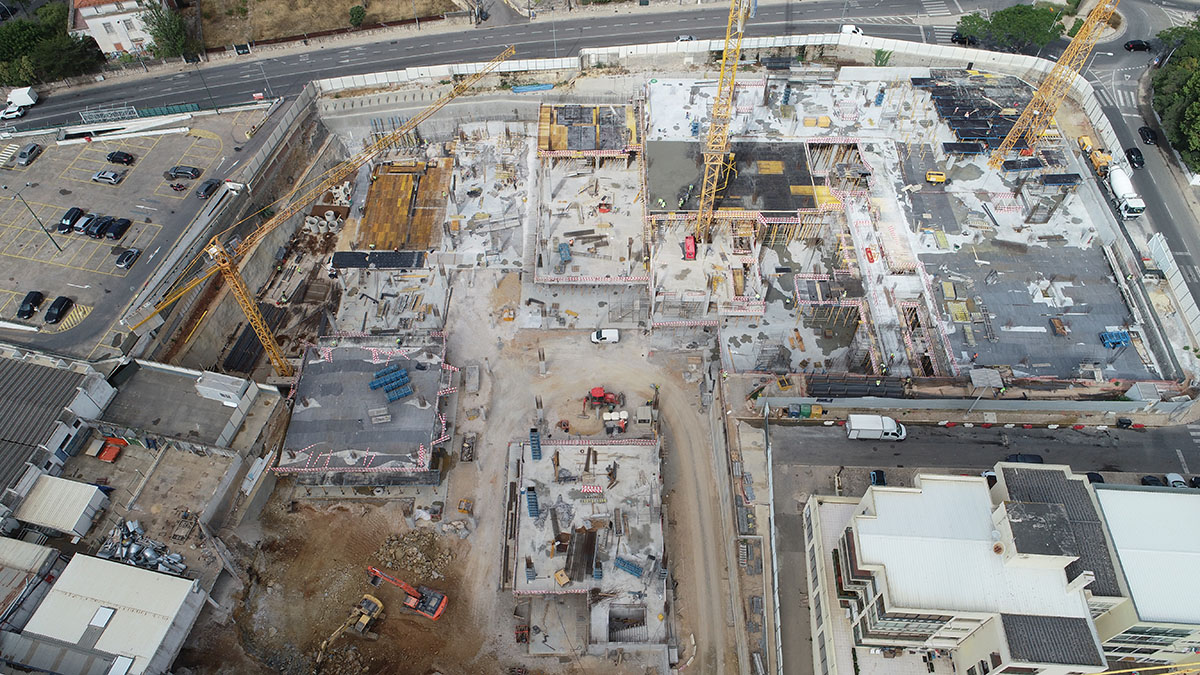

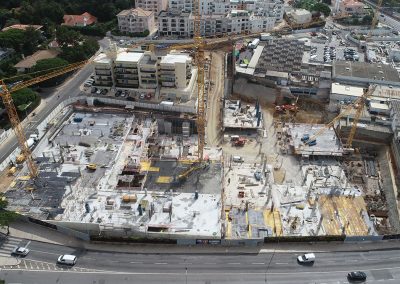

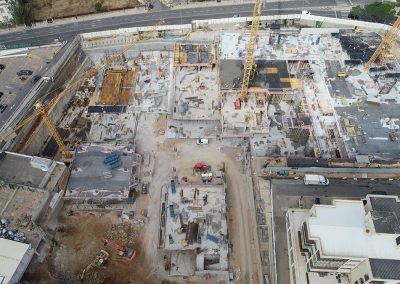

PLOT 4 (up to Silo)

• Demolitions, Excavations and Containment completed

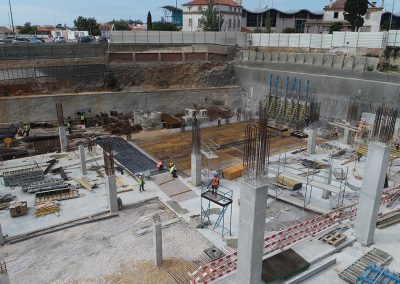

• Foundations completed
• Burried structures of the new supermarket technical area – concluded

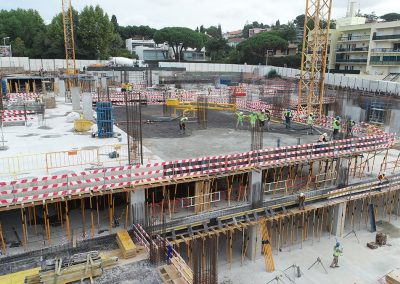

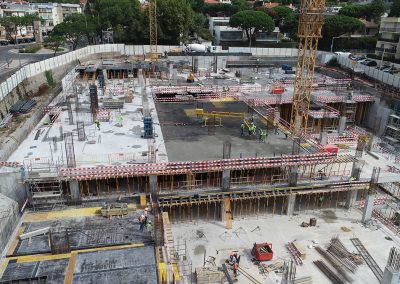

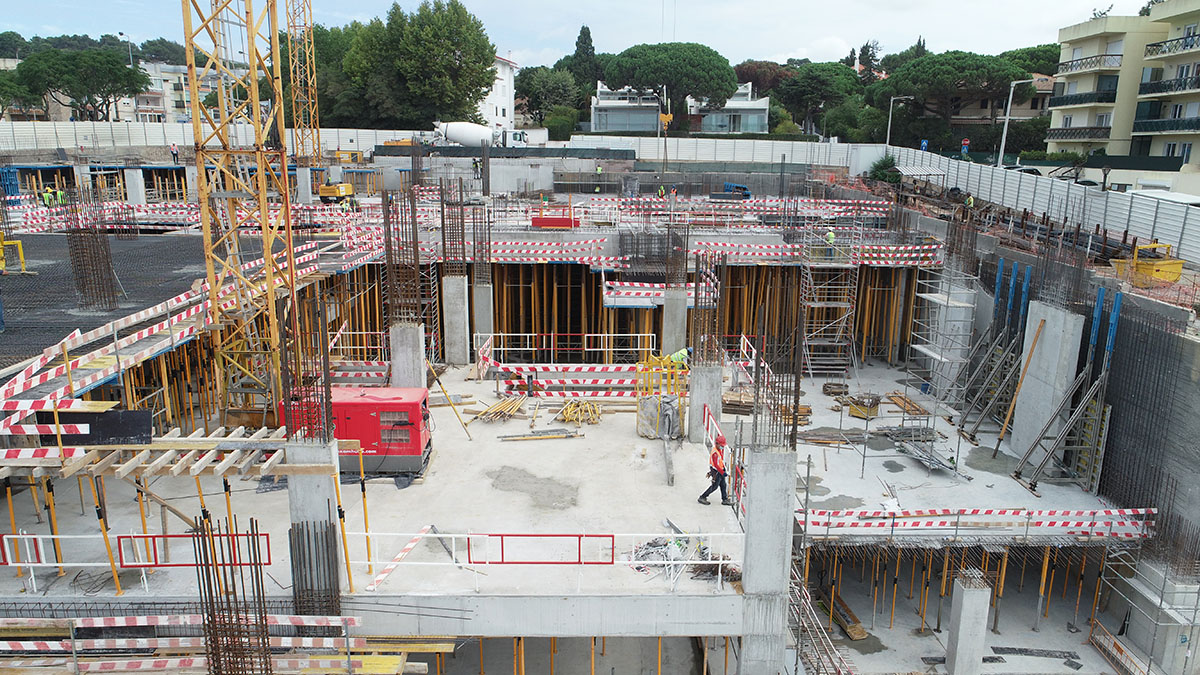

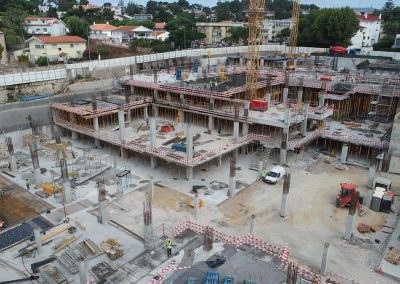

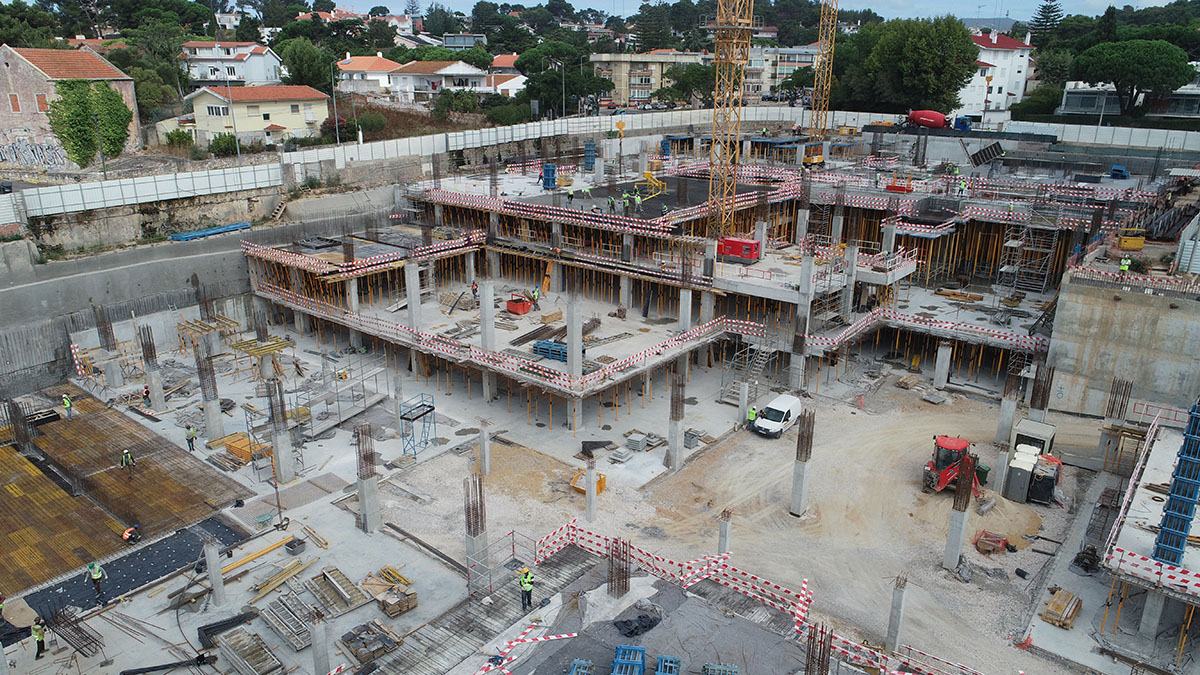

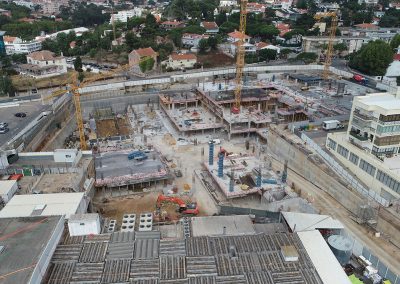

• Vertical elements and 1st level slab – In progress

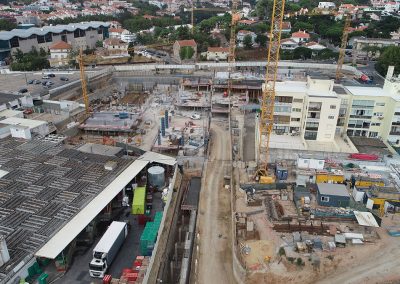

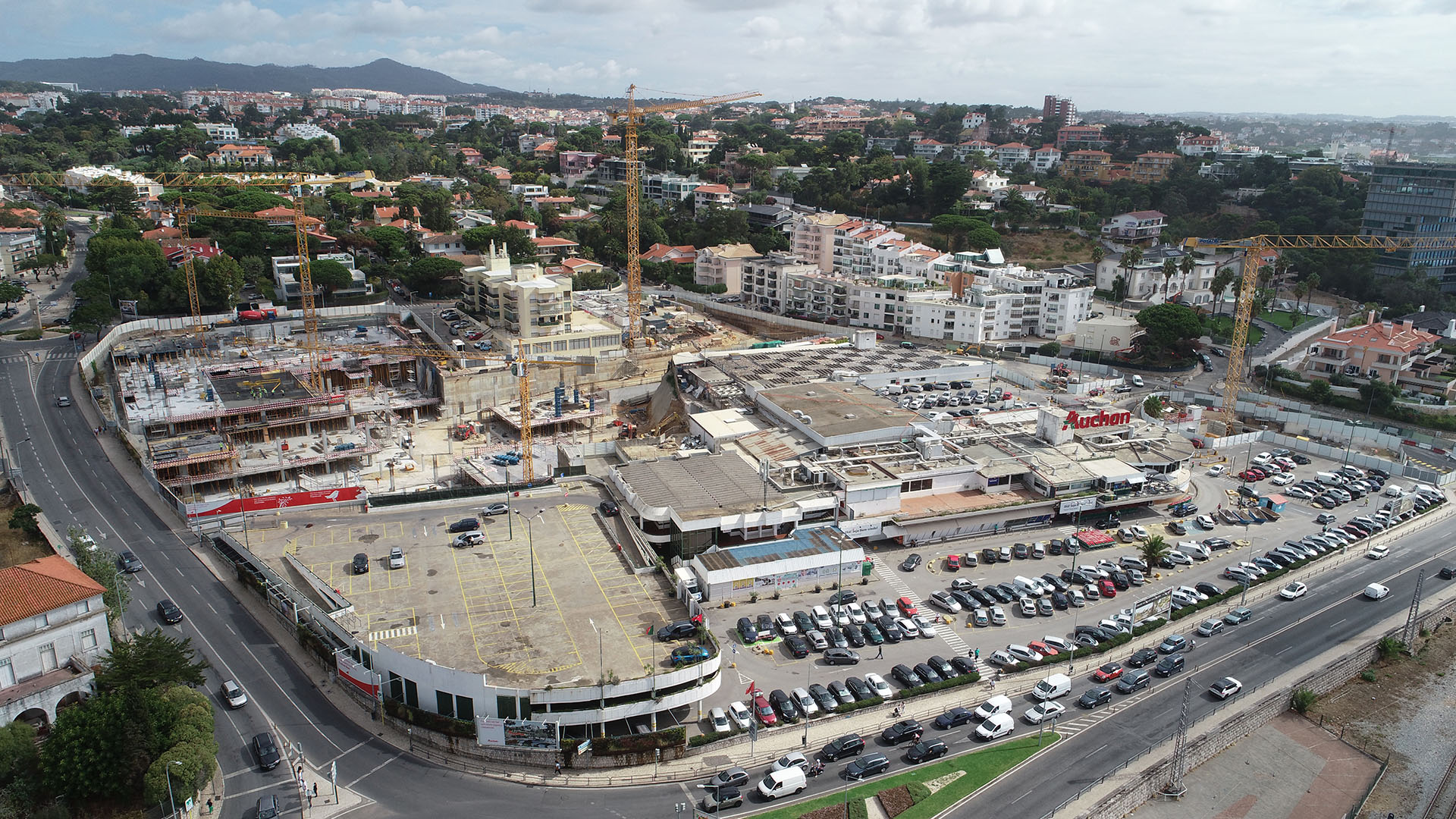

CURRENT SUPERMARKET IN EXPLORATION

Adaptation works started, for future operation with adapted layout

 GENERAL INFRASTRUCTURES

With the monitoring, inspection, and follow-up of public service concessionaires – EDP, PT, ÁGUAS DE CASCAIS, CÂMARA MUNICIPAL DE CASCAIS, GALP ENERGIA

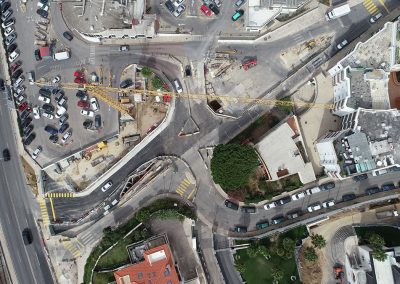

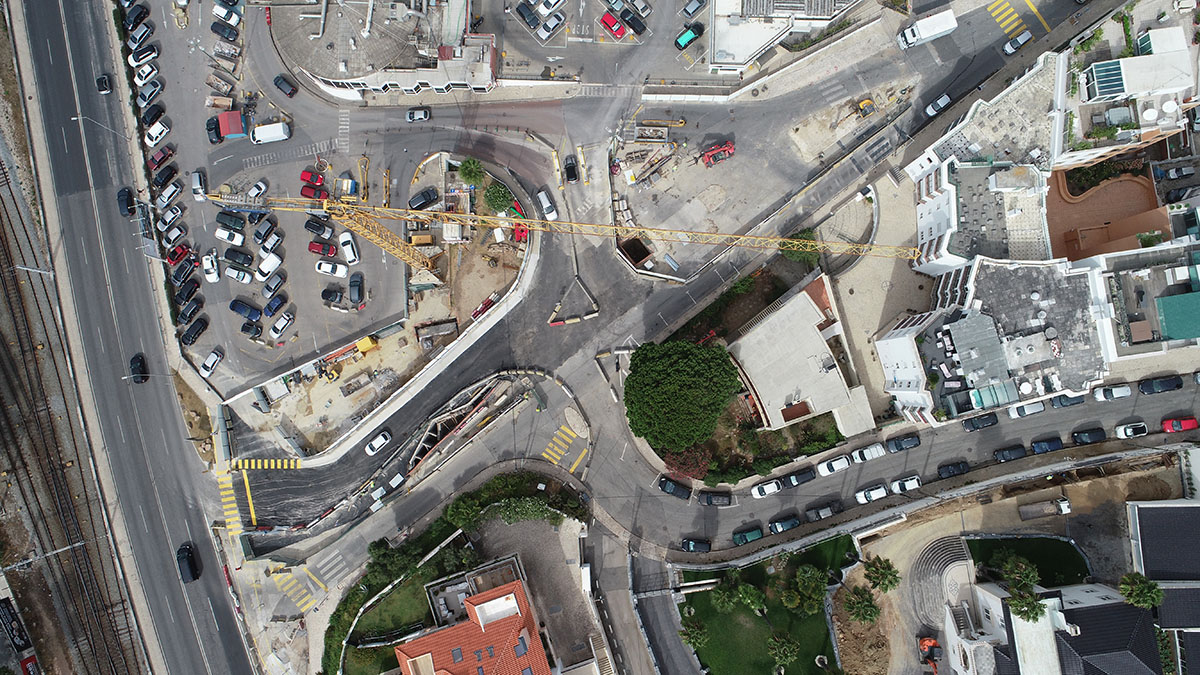

AV. MARECHAL CARMONA
• North tunnel under development
• Excavations and South Tunnel containment under development
• Remaining buried infrastructures ongoing

AV. MARGINAL
• Pluvial Sewer Connection to Ribeira da Castelhana concluded
