JANUARY / 2021

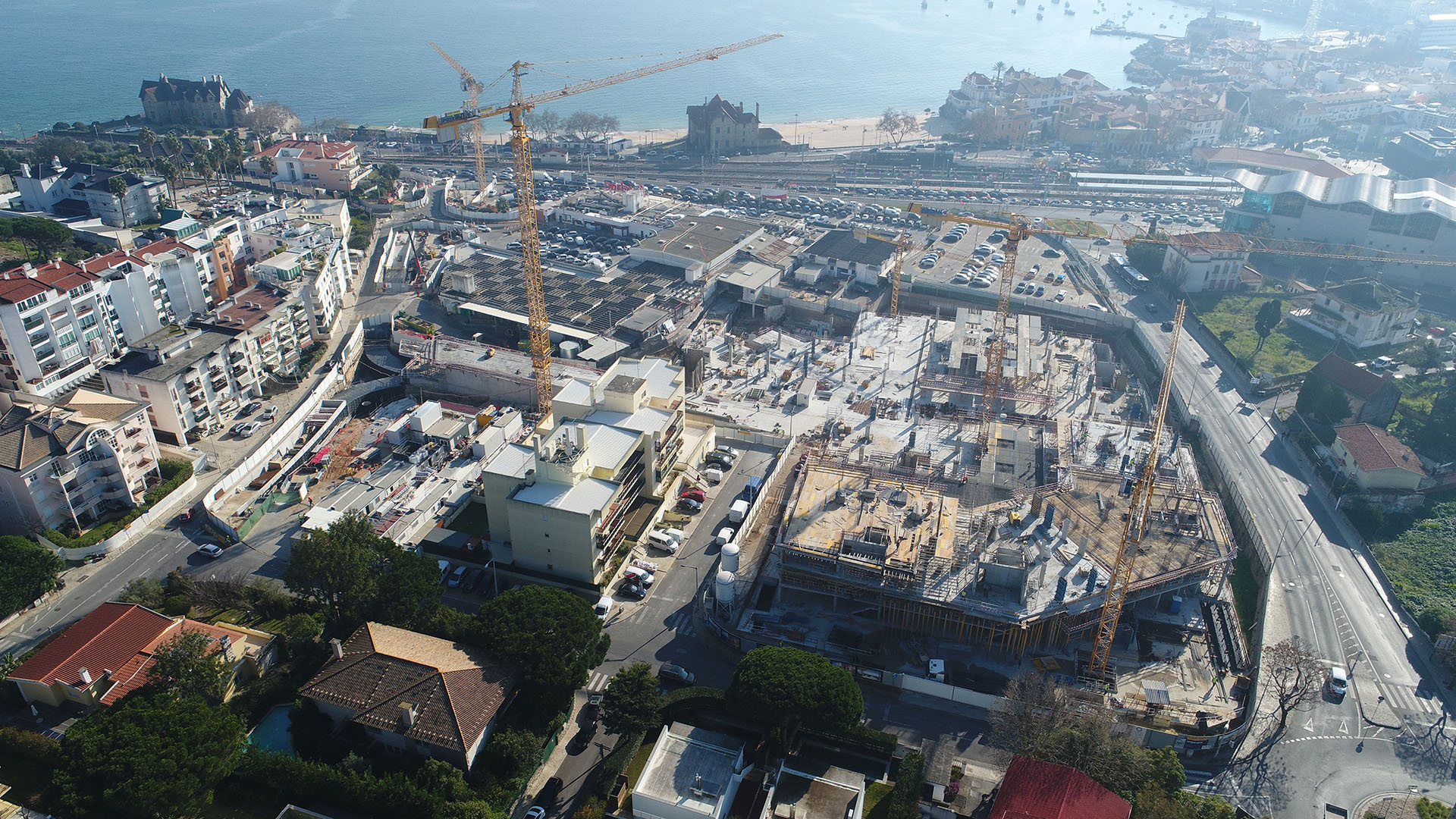

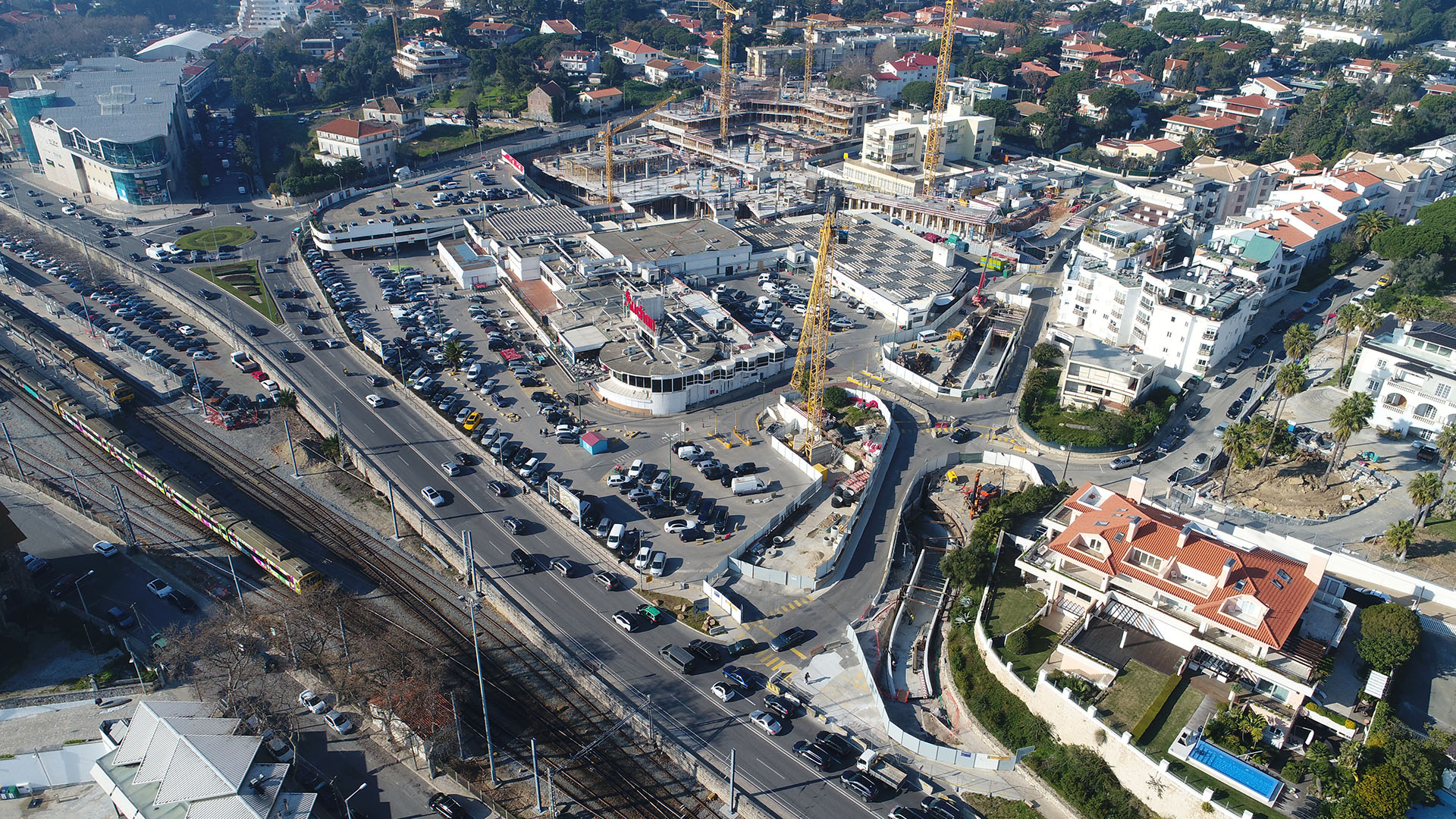

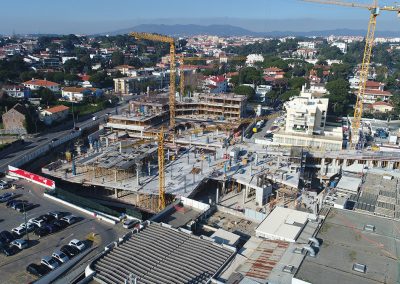

BUILDINGS WITHIN PLOTS

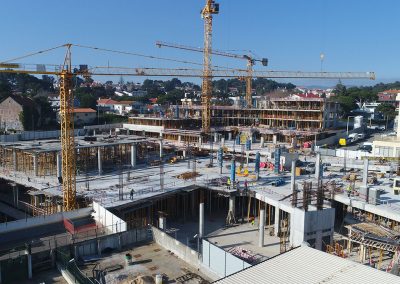

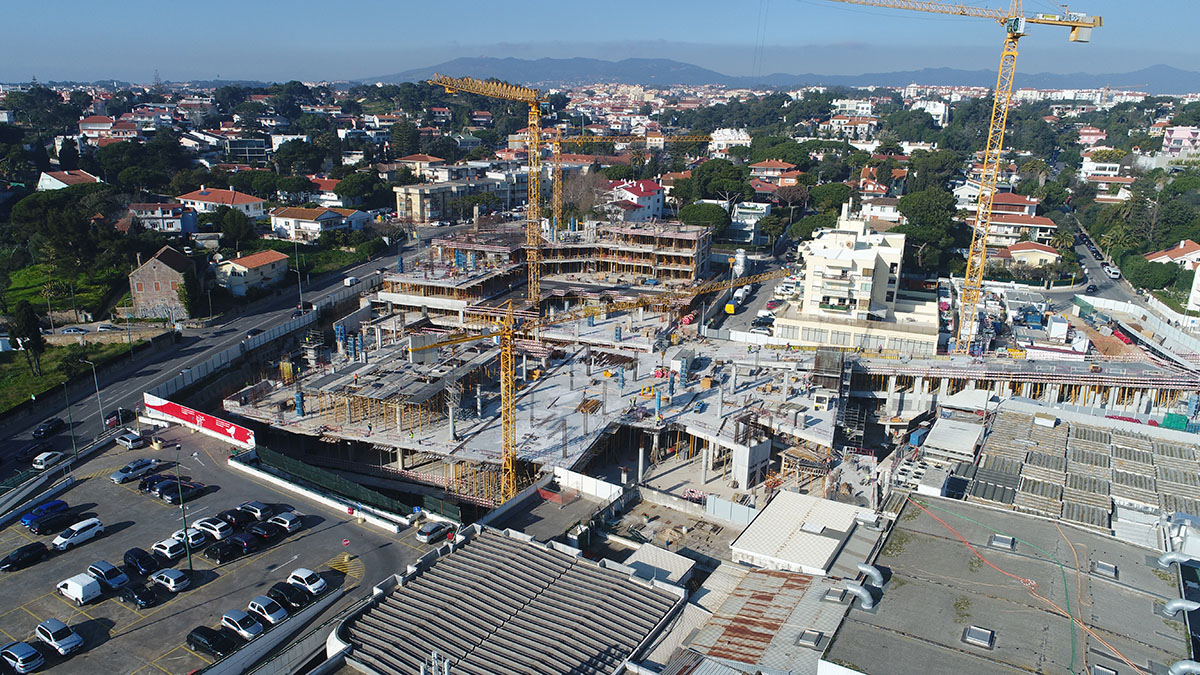

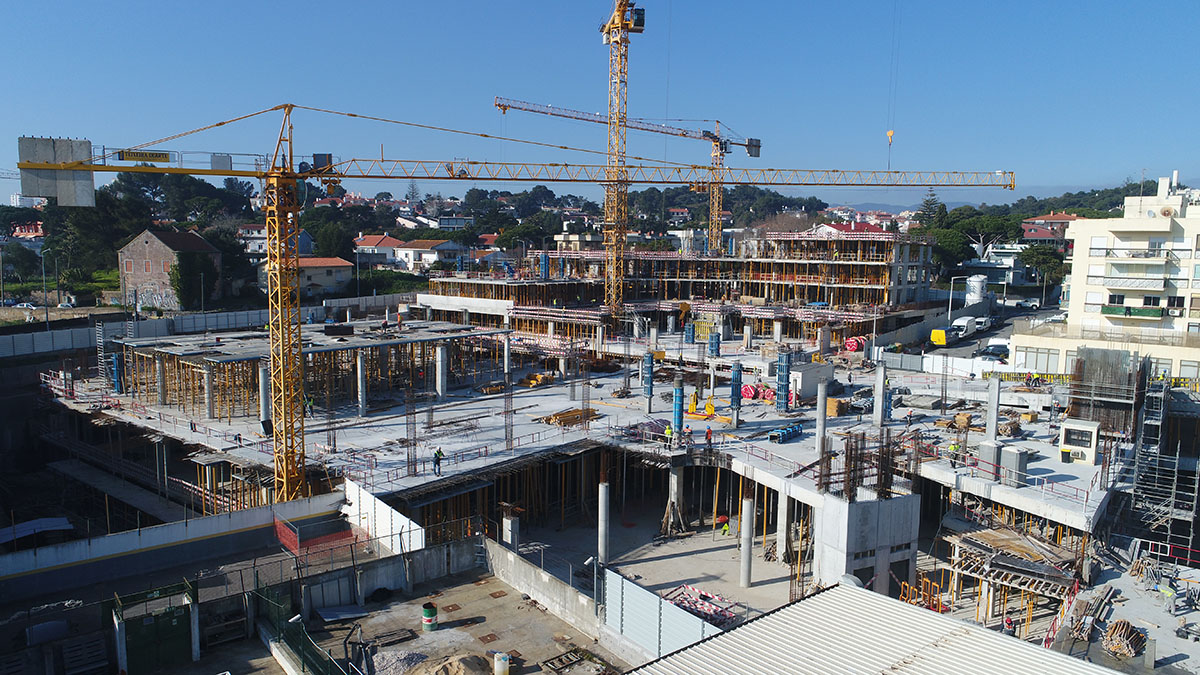

PLOT 2
- Demolitions, Excavations, Containment and Foundations completed
- Drainage and Ground Slab concluded
- Vertical Elements and 1st Level Slab – Completed
- Vertical Elements and Intermediate and 2nd Level Slab – Completed
- Vertical Elements and Housing Parking Slab – Completed

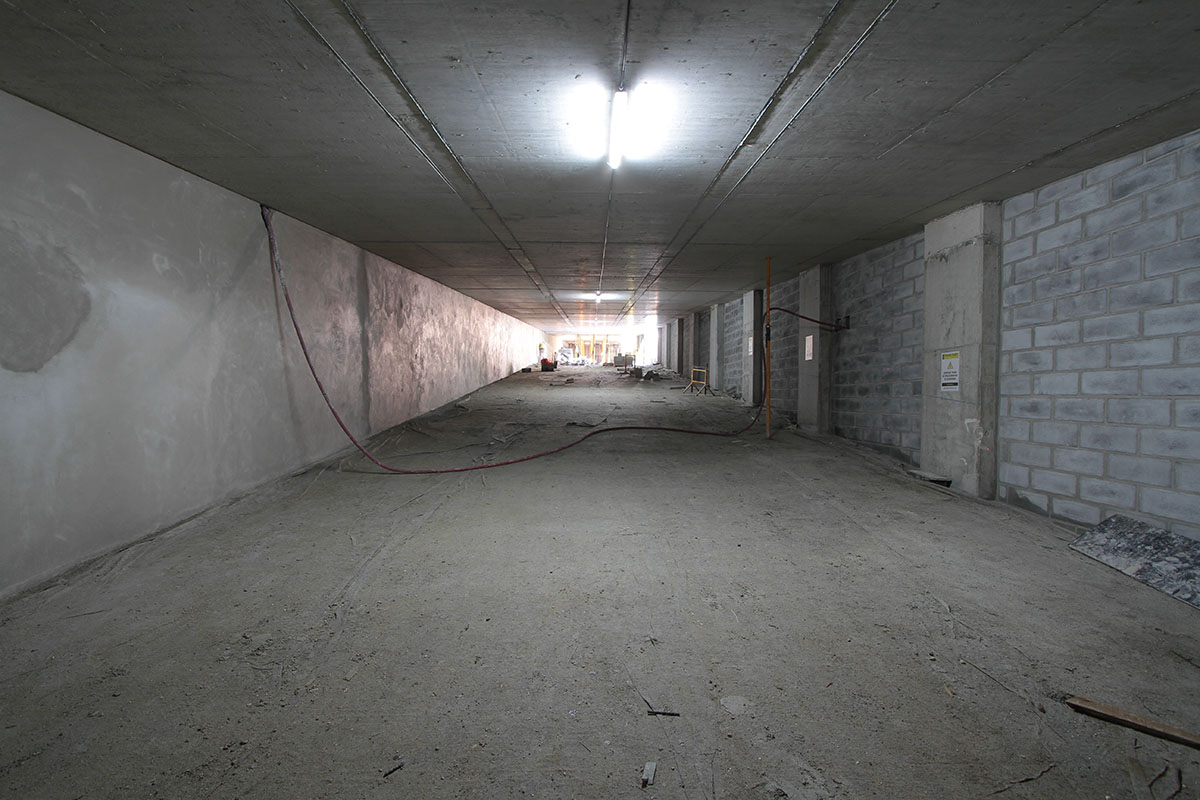

- Vertical Elements and ground floor housing slab – Completed
- Vertical elements and 1st floor slab – Completed
- Vertical elements and 2nd floor slab – Completed

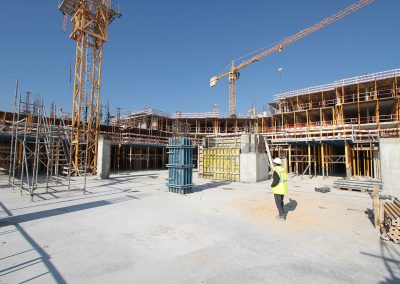

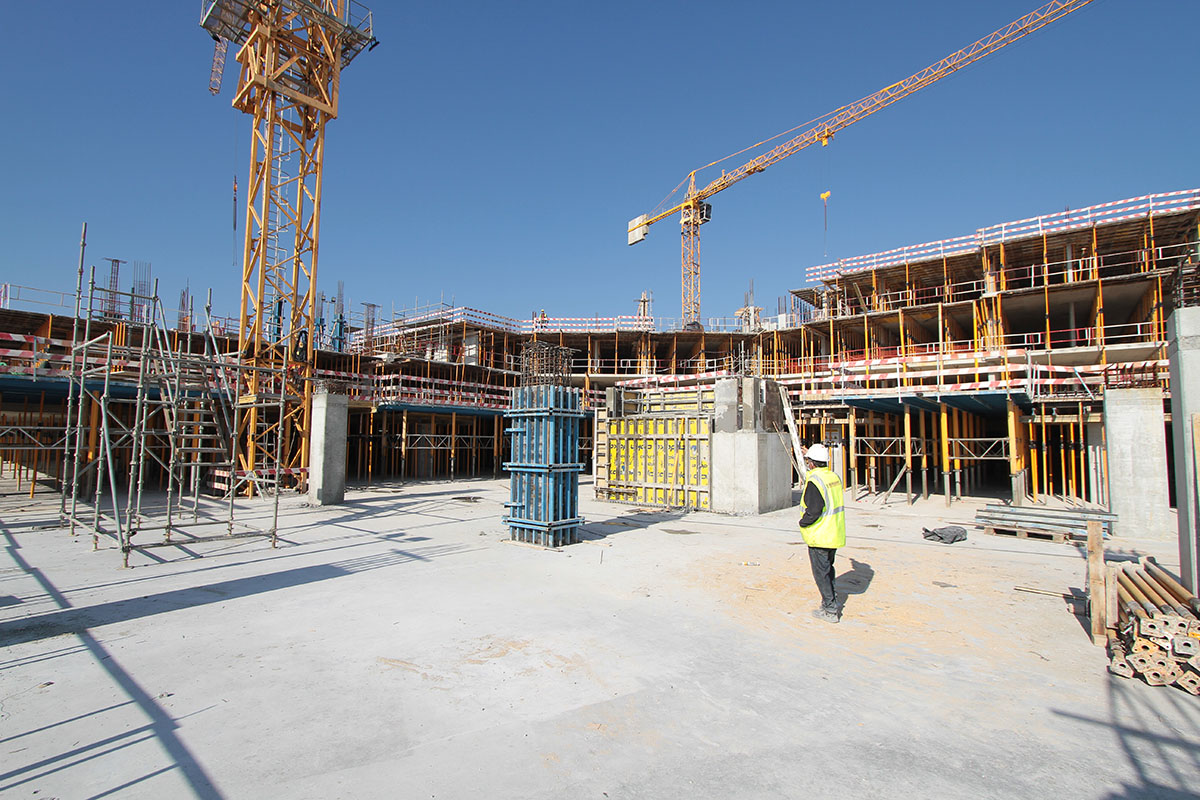

- Vertical elements and 3rd floor slab – In execution
- The Excavations and Containment of the 3 north ramps to Av. Marechal Carmona have been completed
- Vertical Elements and Slabs in Elevation of the 3 ramps have been completed

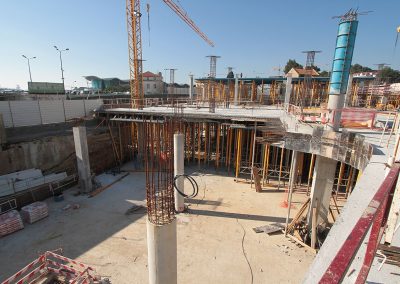

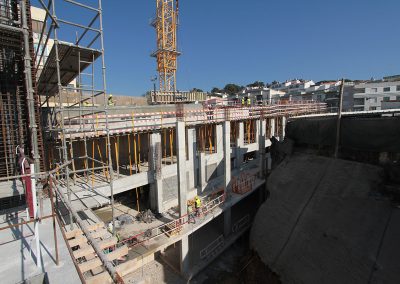

PLOT 4 (up to Silo)
- Demolitions, Excavations and Containment completed
- Foundations completed
- Burried structures of the new supermarket technical area – concluded
- Vertical elements and 1st level slab – concluded
- Vertical elements and roof slab of the New Supermarket – concluded

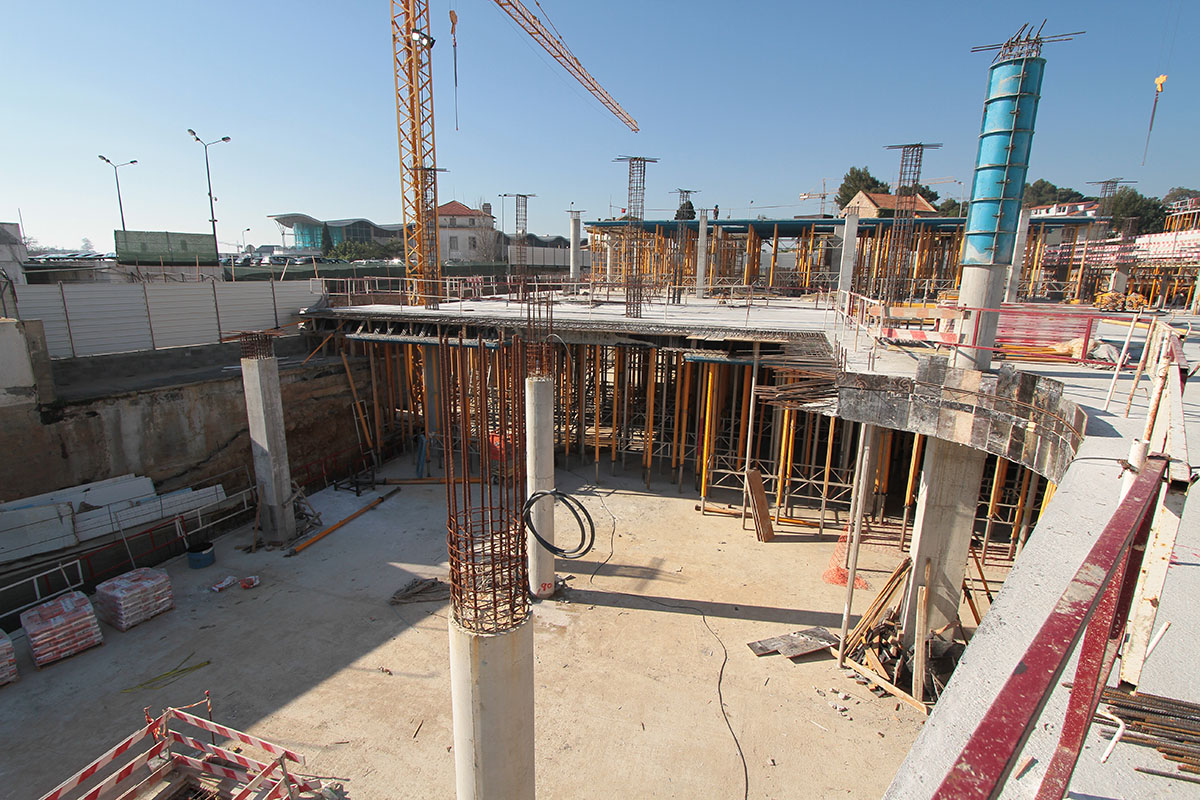

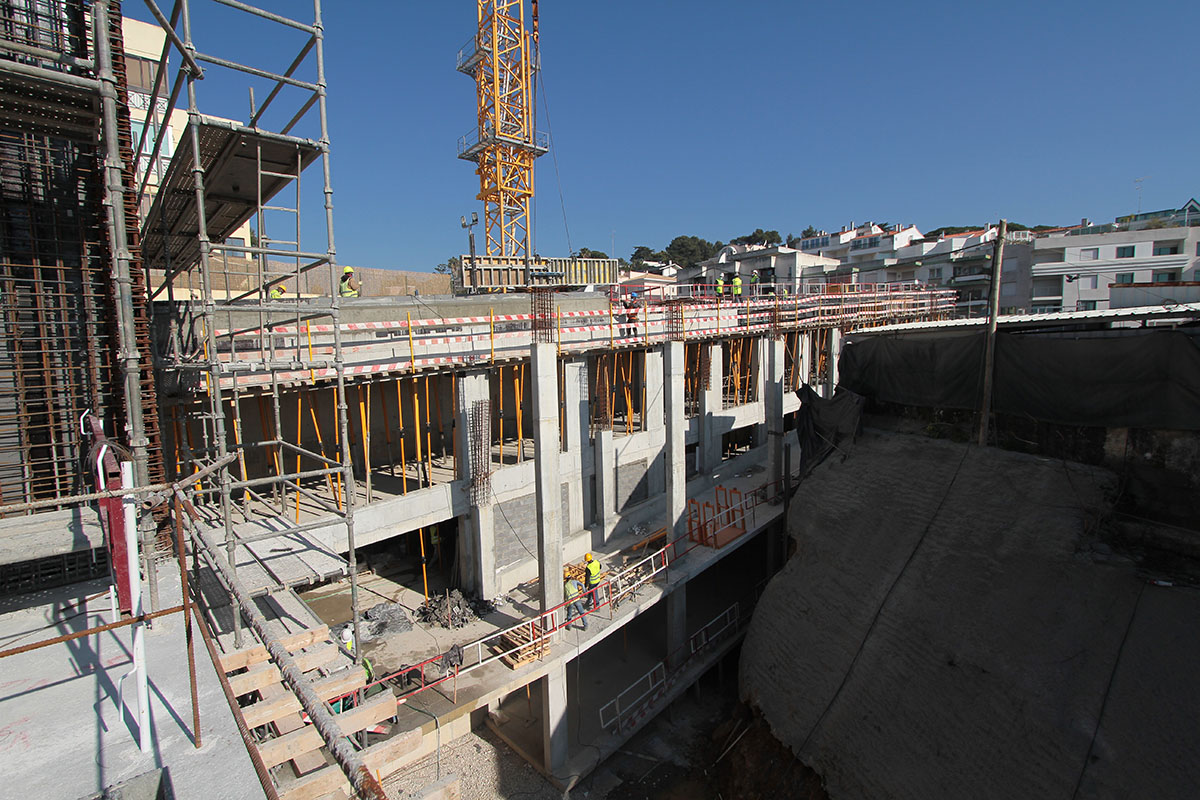

- Vertical Elements and Food Court Slab – In Execution

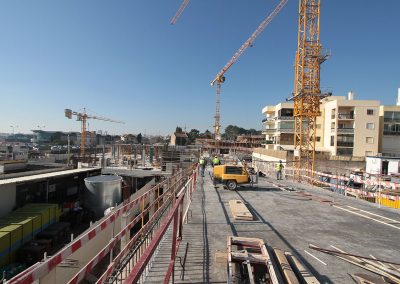

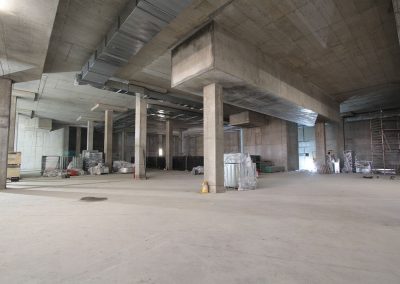

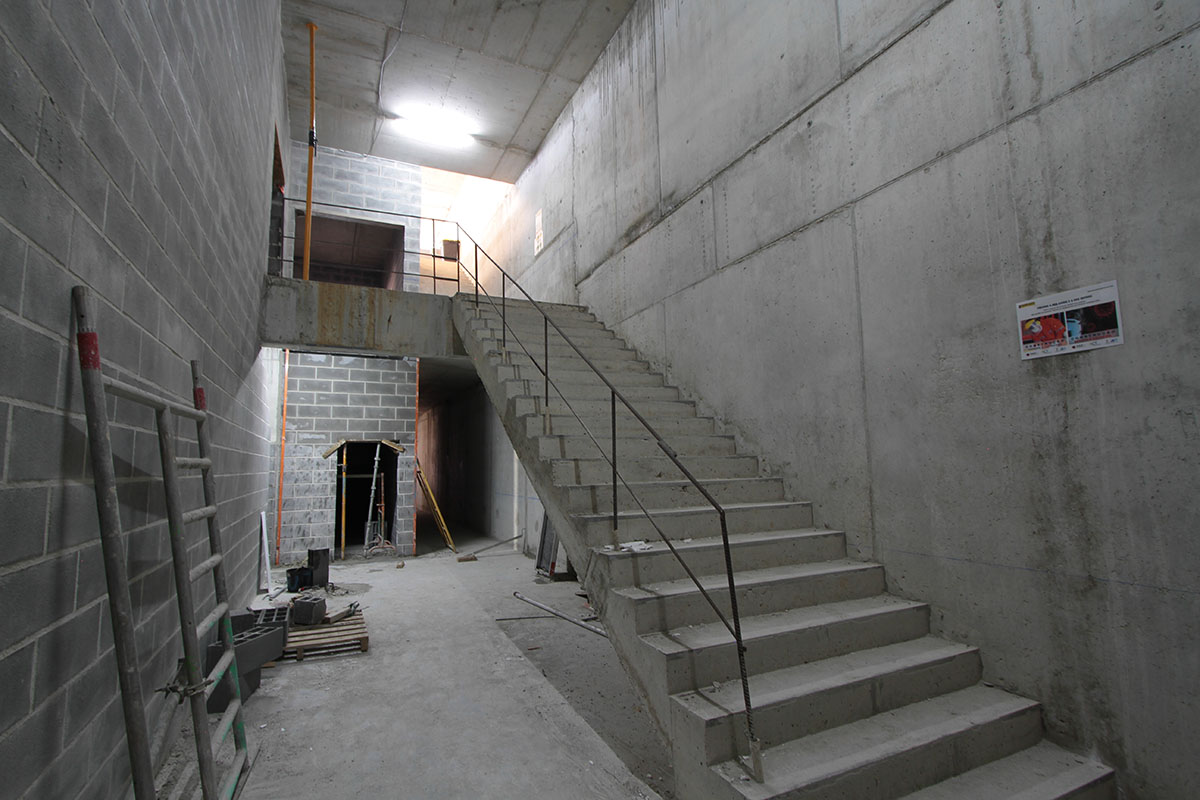

COMMERCIAL PROJECT – PLOTS 2 AND 4

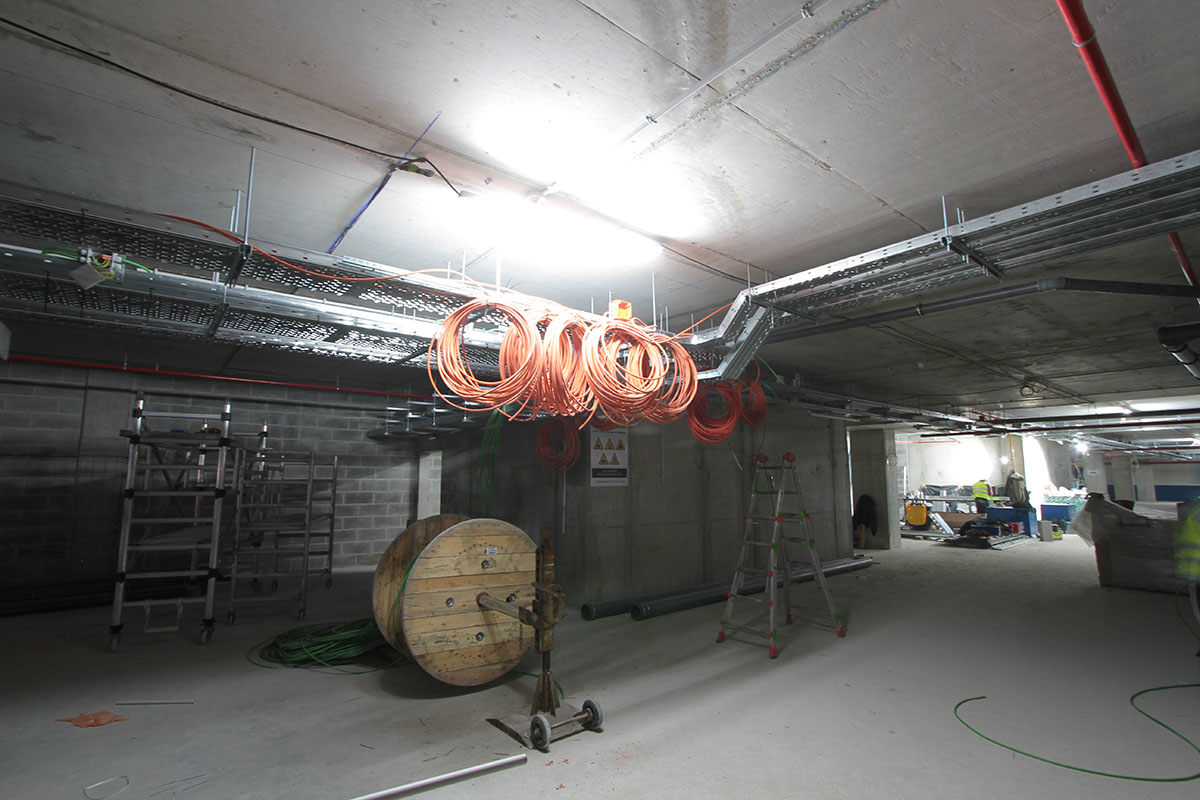

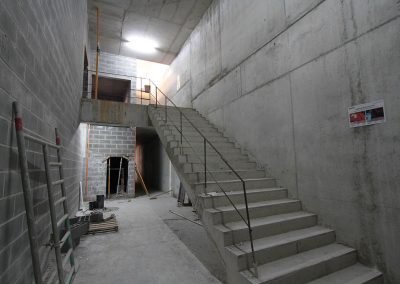

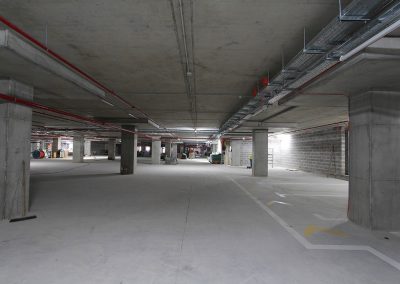

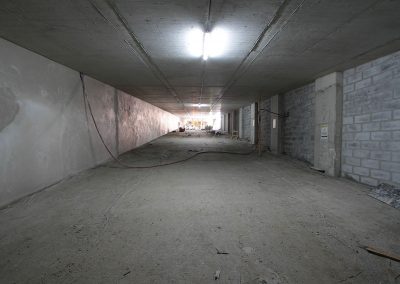

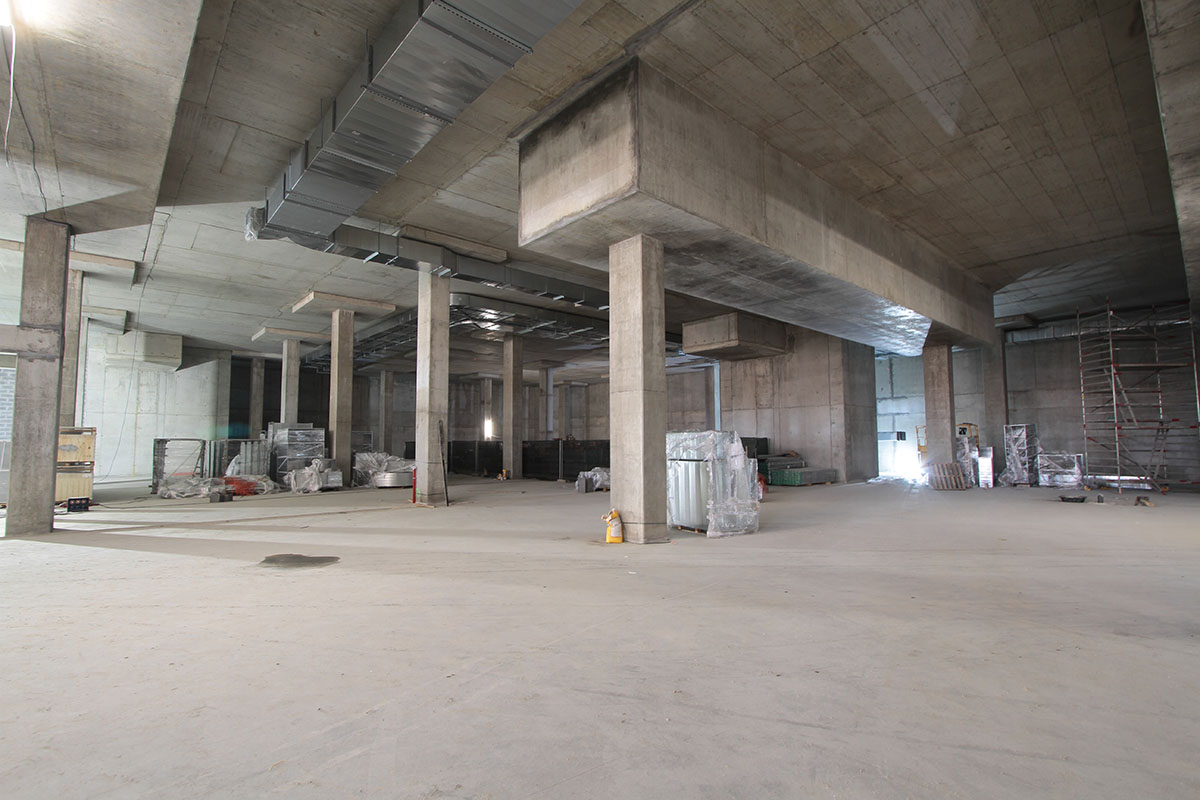

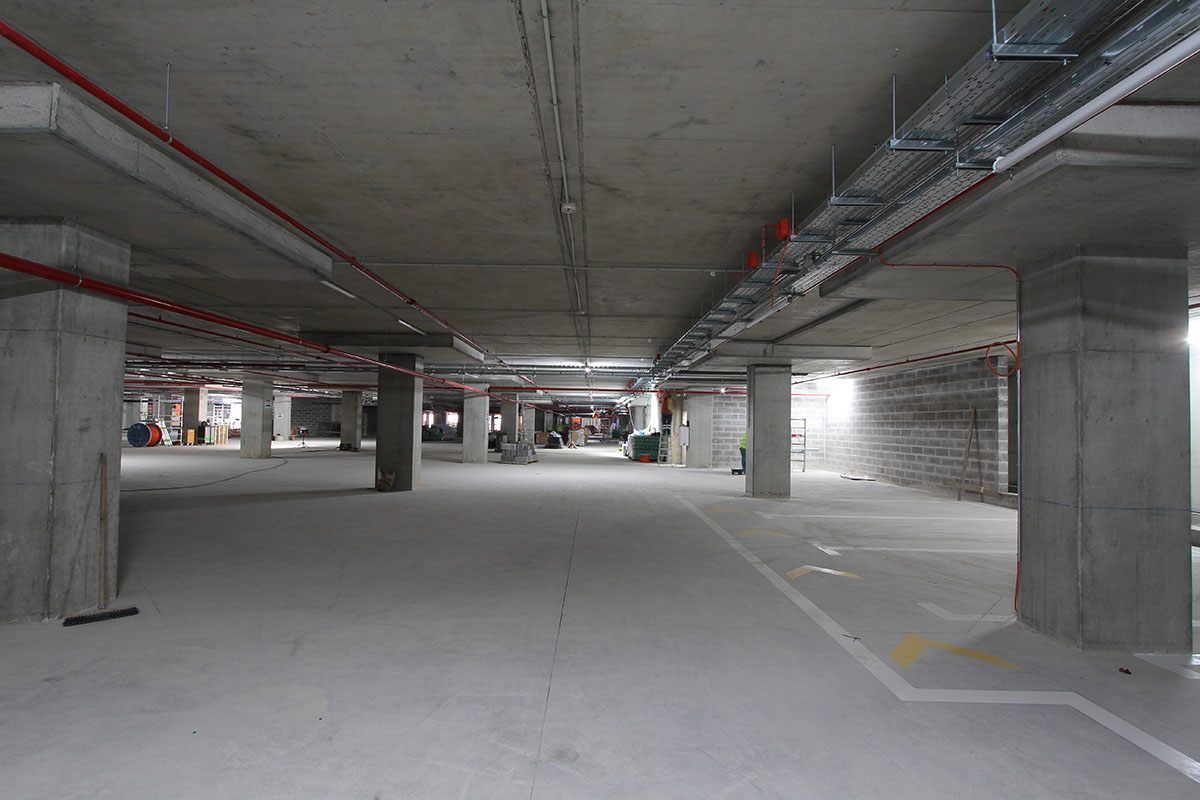

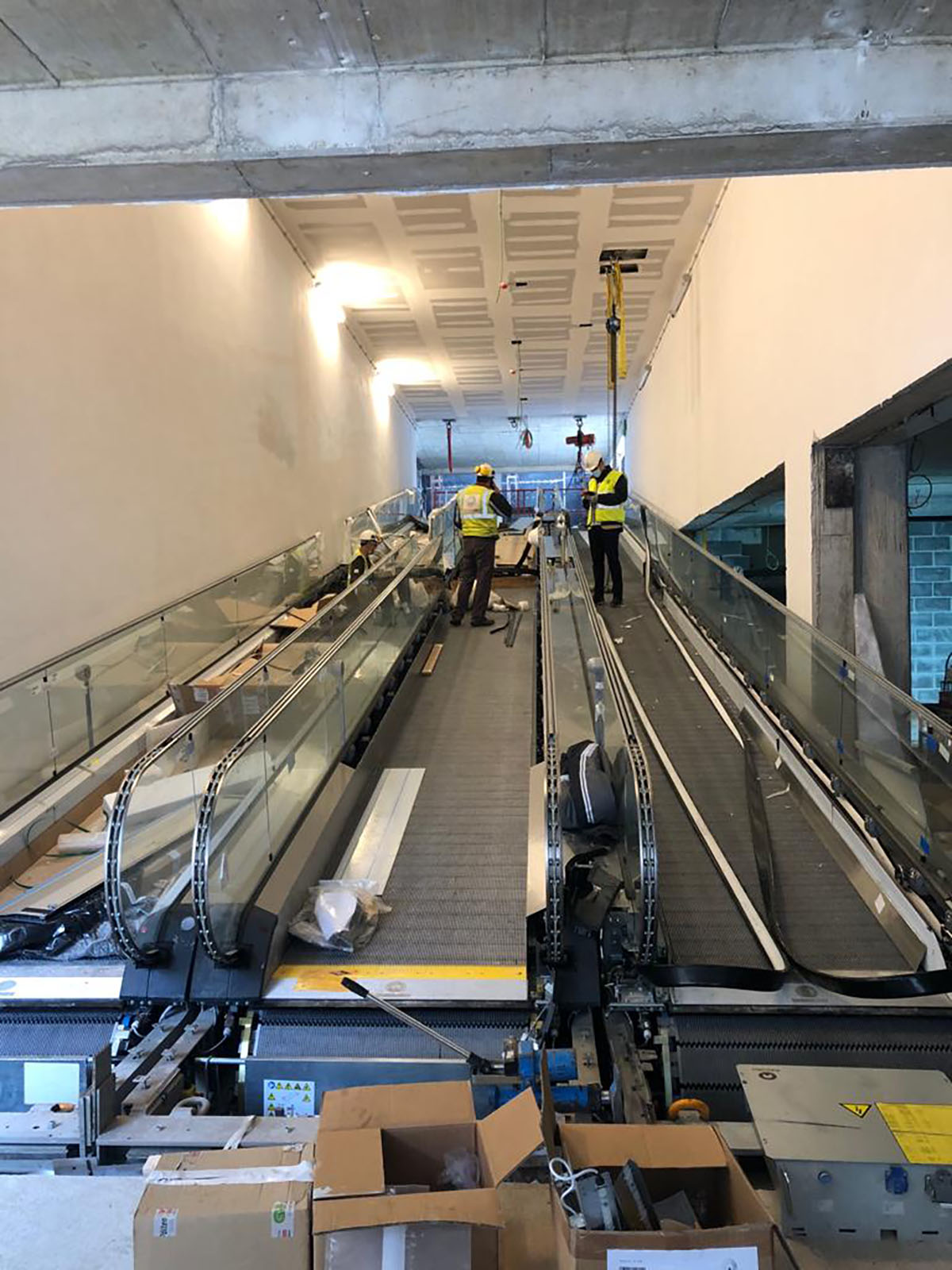

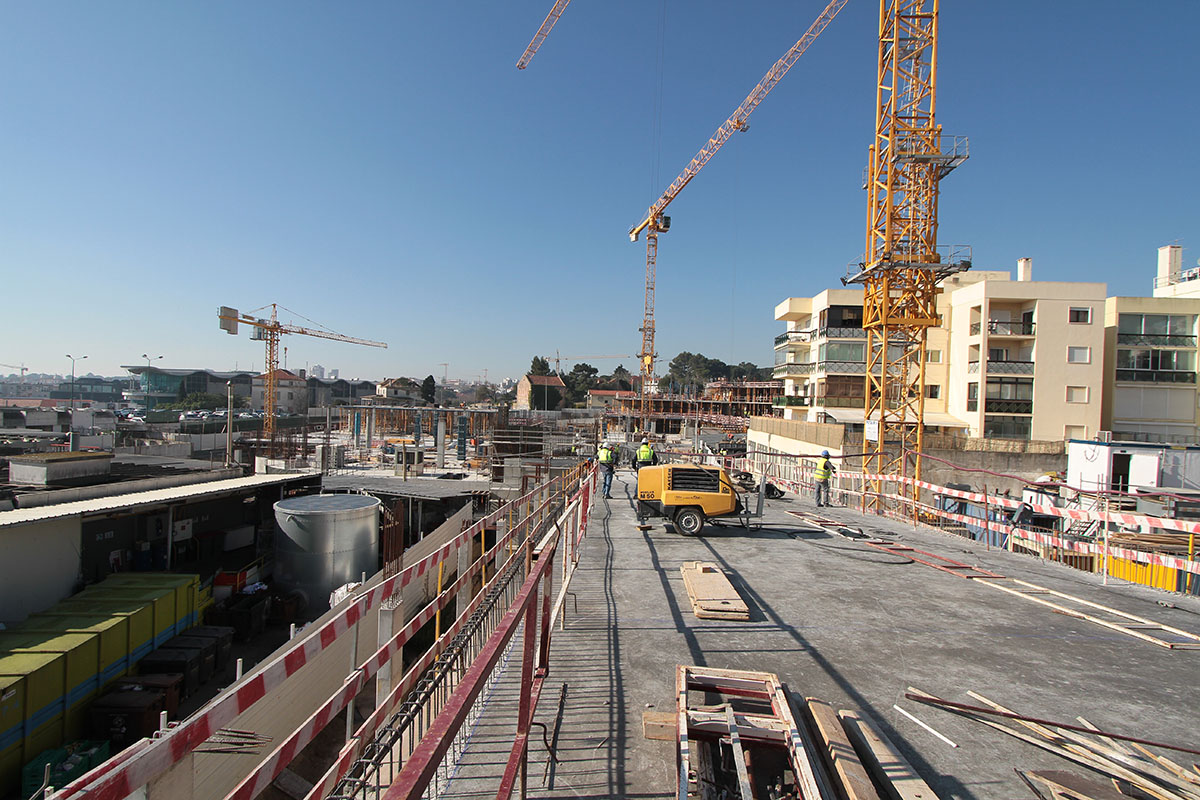

- Finishes and Special Installations for Parking at Level 9.50 – In execution

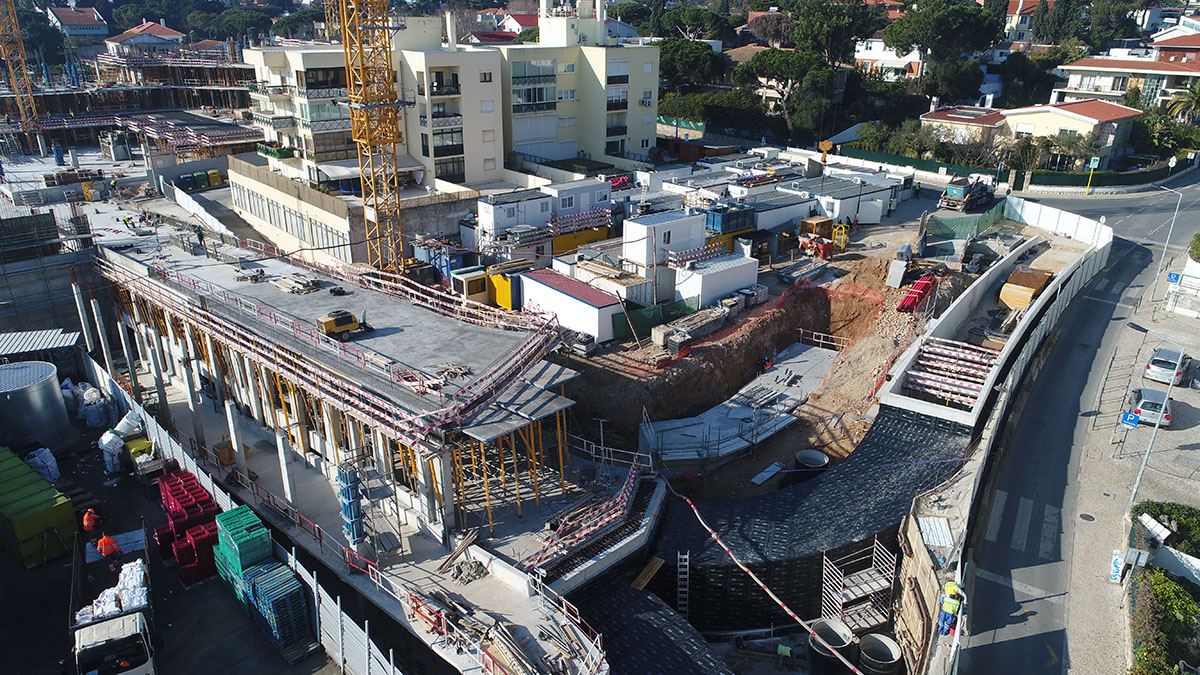

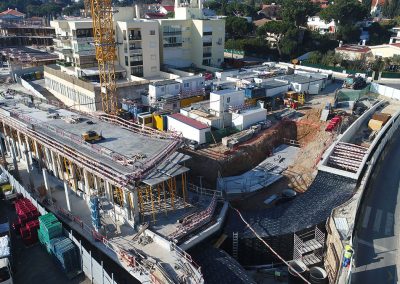

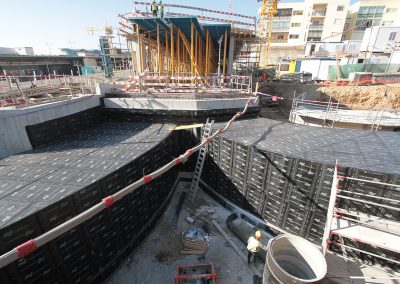

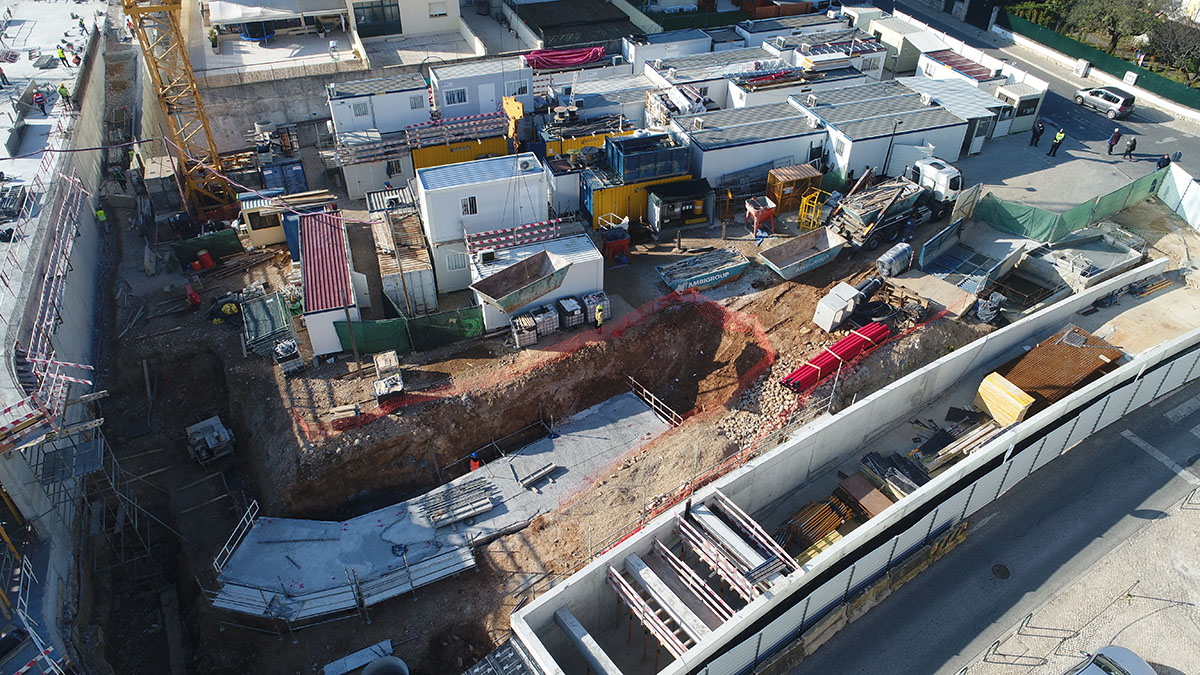

PLOT 3
- Works have been initiated
CURRENT SUPERMARKET IN EXPLORATION

Completed the 1st Stage of the Adaptation Works of the Current Supermarket – Conveyor Foundations
GENERAL INFRASTRUCTURES
With the monitoring, inspection, and follow-up of public service concessionaires – EDP, PT, ÁGUAS DE CASCAIS, CÂMARA MUNICIPAL DE CASCAIS, GALP ENERGIA

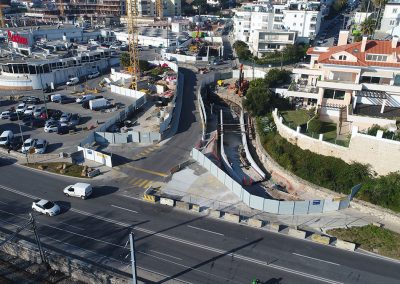

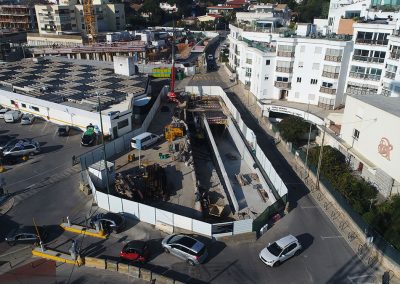

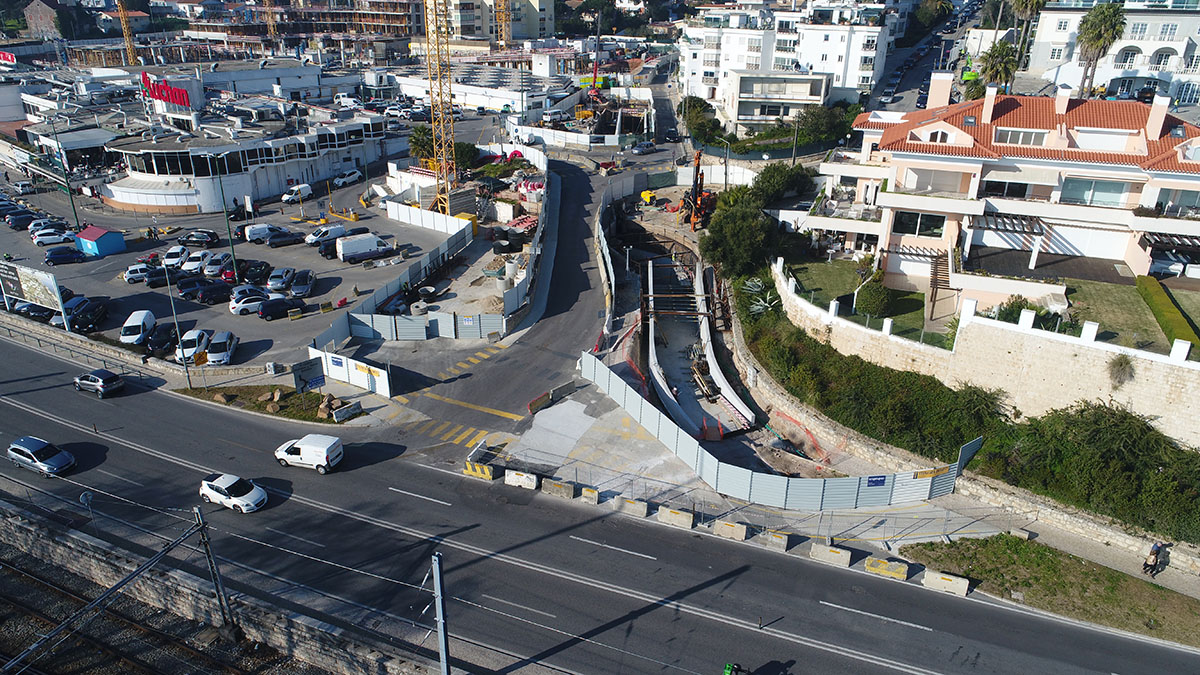

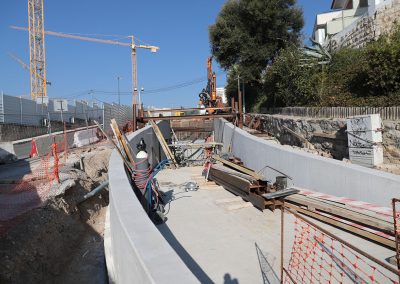

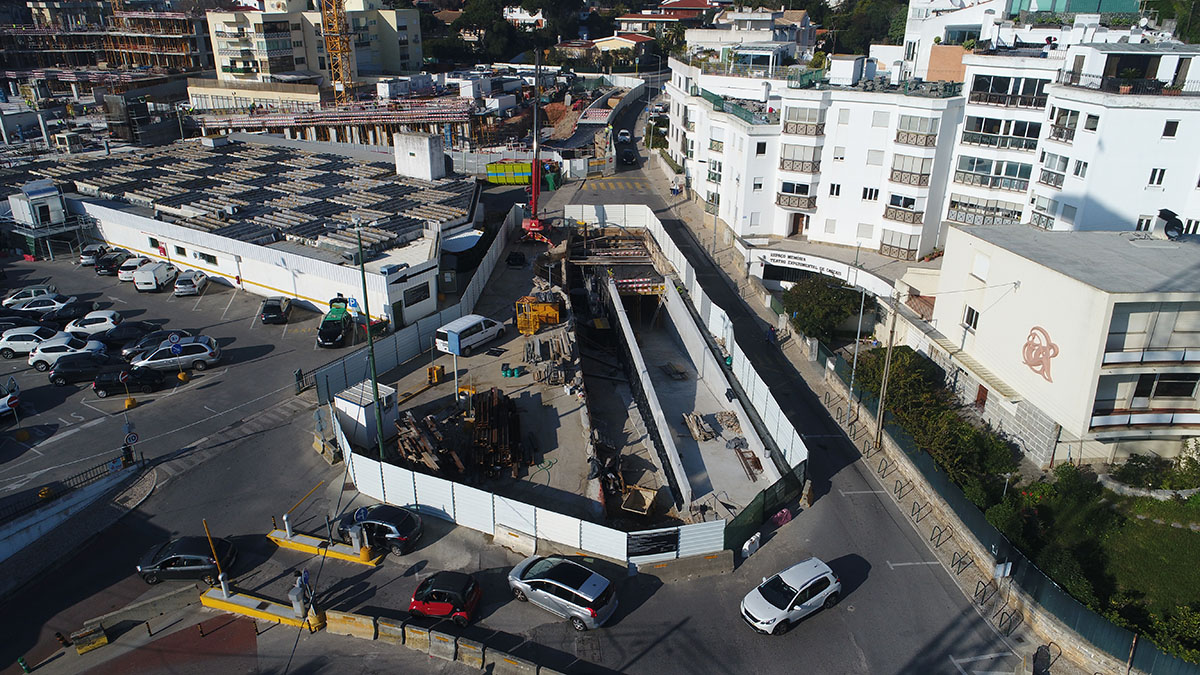

AV. MARECHAL CARMONA

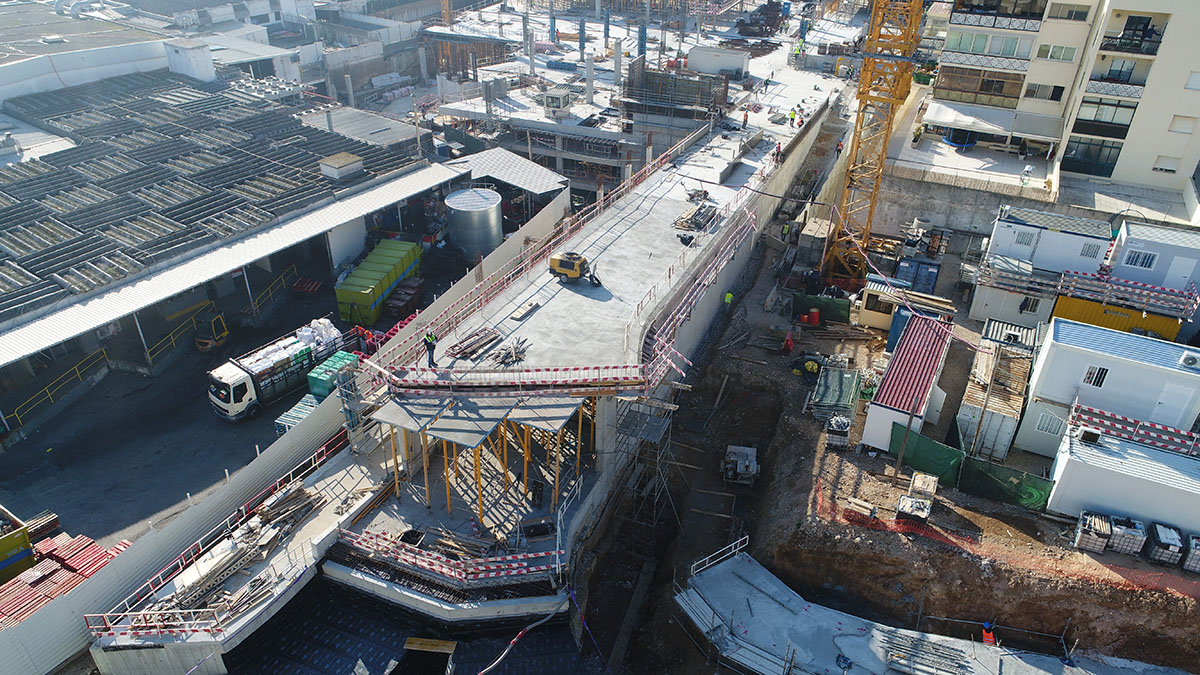

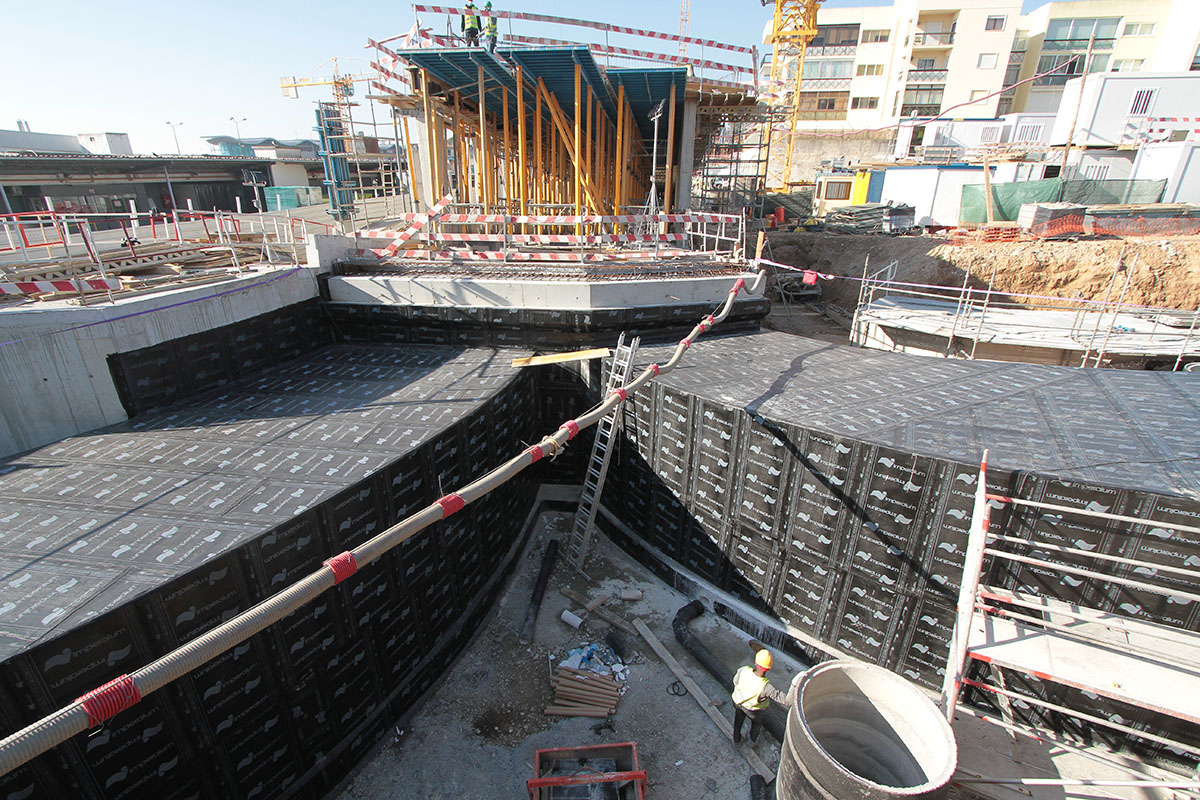

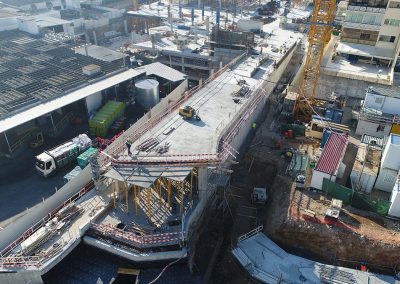

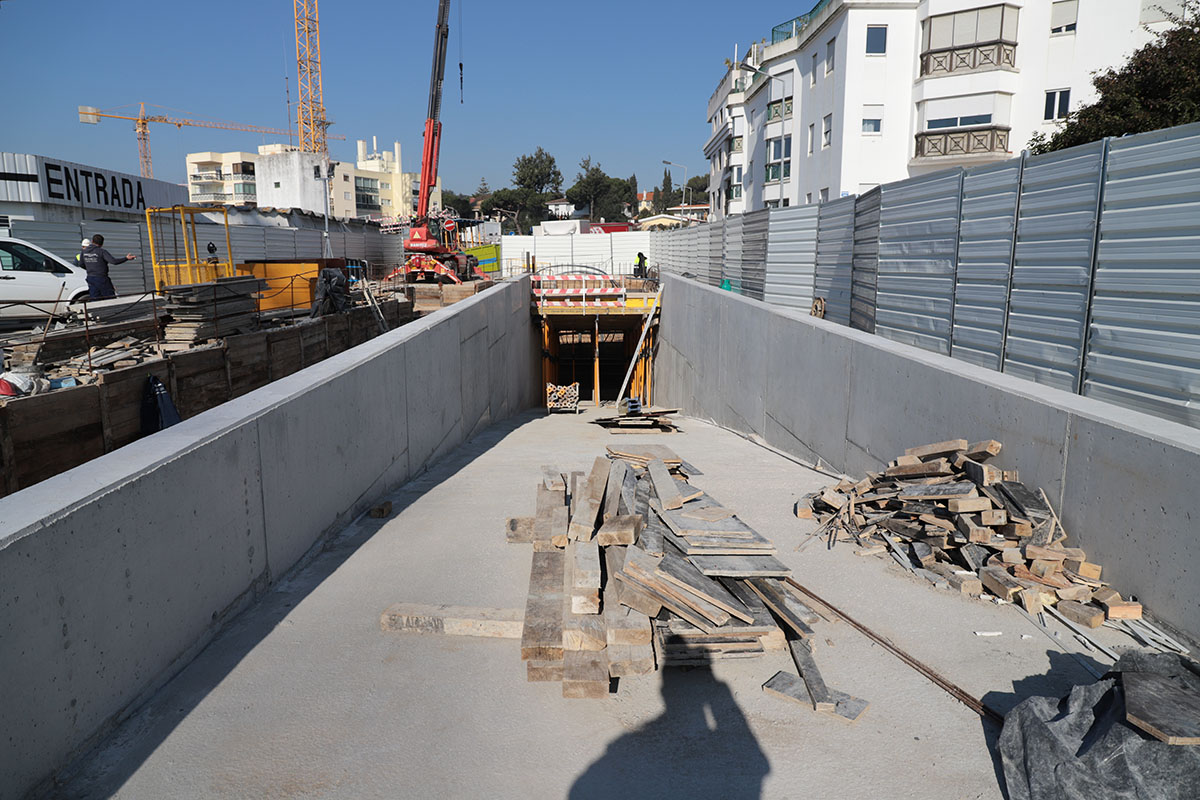

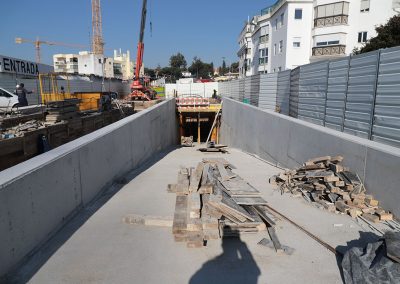

• North tunnel – Cloncluded structure

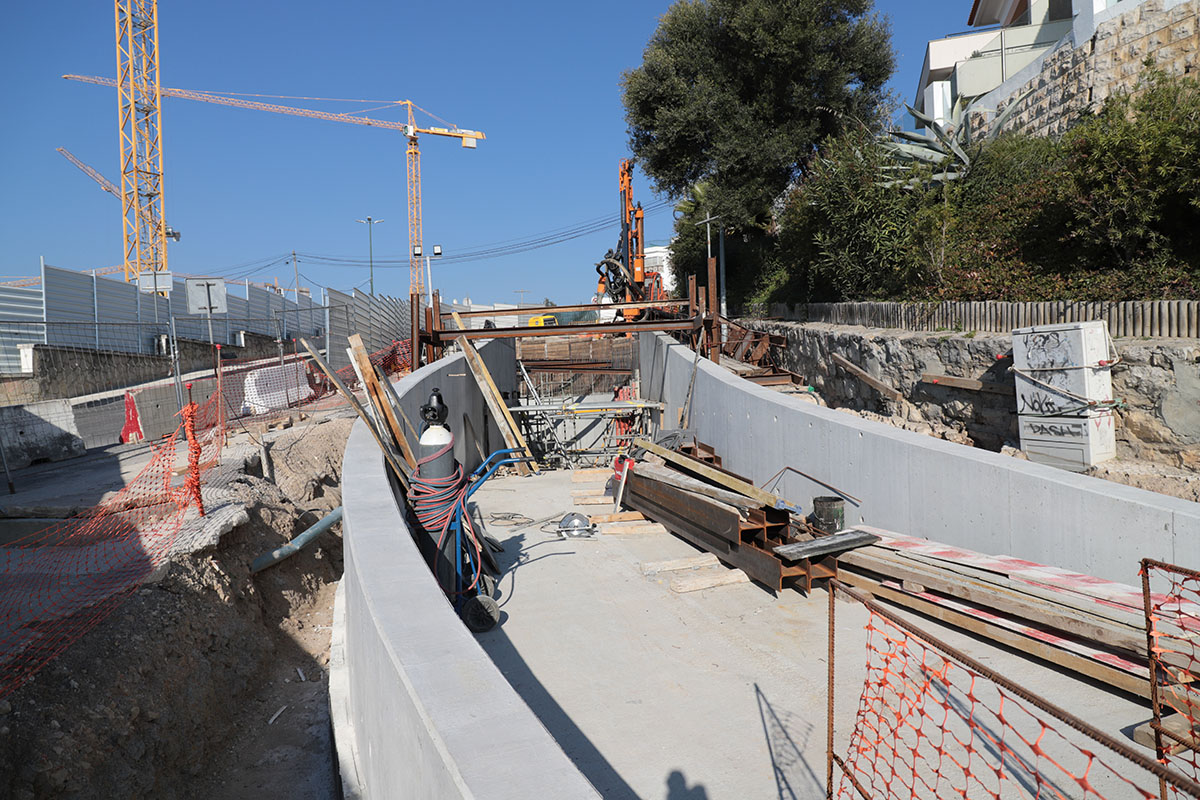

• South Tunnel – Structure in execution
• Intermediate tunnel – Structure in execution

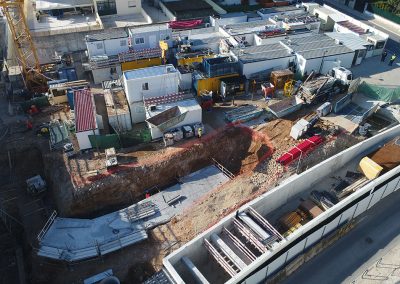

• Remaining buried infrastructures ongoing
AV. MARGINAL
• Pluvial Sewer Connection to Ribeira da Castelhana concluded
